Inside a Thermoplastic Road Marking Paint Factory

Most specifiers never see where their road marking material comes from, and manufacturers of thermoplastic paints rarely open the doors. That is a shame, because almost every property you will later argue about on site is fixed inside the plant. Binder grade, pigment loading, bead content and batch consistency are all decided long before a kettle is lit. This article walks through what actually happens in production and what it means for the material arriving at your works.

Key Takeaways

  • Thermoplastic is manufactured as a dry blend. There is no solvent, so formulation controls performance almost entirely.
  • Batch records tie a delivered pallet back to specific raw materials and test results, which is the basis of any real warranty claim.
  • A trader can supply the same looking product without any ability to explain or repeat what is inside it.

What Actually Goes Into the Batch

A thermoplastic road marking material is a dry blend of four component groups, and the proportions between them decide almost everything about how the finished line behaves.

The binder is a hydrocarbon resin system, often modified with plasticiser and oil to control brittleness at low temperature and softening at high temperature. Filler, usually calcium carbonate or graded quartz sand, makes up the bulk and supplies abrasion resistance. Pigment provides colour, with titanium dioxide doing the work in white formulations and chrome free pigments in yellow. Glass beads are added as intermix so that the material can renew its own night performance as it wears.

For the Gulf market, binder grade is the decision that matters most. It is also the one most easily downgraded without any visible change to the product.

Yellow formulations follow the same structure with a different pigment package. The change sounds trivial and is not, because yellow pigments differ from titanium dioxide in opacity, in cost and in how they age under ultraviolet light. A yellow line will normally carry a lower retroreflectivity target than a white one for exactly this reason, and specifying the same value for both is a common specification error.

Raw Material Intake and Testing

Production quality starts at the gate. Every incoming raw material is sampled and checked against the specification the formulation depends on, and no batch is released into production before those checks pass.

Resin is checked for softening point and colour, because a resin that is off grade will shift the behaviour of the finished material at exactly the temperatures that matter here. Filler is checked for particle size distribution and moisture, since damp filler causes problems in the melt. Pigment is checked for whiteness and consistency, because low pigment loading produces a slightly grey line that will fail a luminance test. Glass beads are checked for roundness and gradation.

Each accepted delivery is logged against a lot number. That number is what later allows a finished pallet to be traced back to the exact materials that went into it.

Storage between intake and production is part of the quality chain and is easy to neglect. Filler and finished material both need to stay dry, because moisture trapped in the product causes foaming and poor flow the moment it reaches kettle temperature on site. A plant that tests raw materials carefully and then stores them badly has gained nothing.

Supplier qualification sits behind all of this. A plant that buys resin from whichever source is cheapest each quarter will produce material that varies from batch to batch, however carefully it tests. Stable supply relationships are unglamorous and they are a large part of why one manufacturer delivers consistent product and another does not.

Infographic showing the manufacturing sequence used by manufacturers of thermoplastic paints

From raw material intake to a traceable pallet leaving the plant

Hot Blending and Why Sequence Matters

Blending is done hot, in a heated mixer, and the order in which materials are introduced changes the result. This is process knowledge rather than recipe knowledge, and it is where experienced manufacturers separate themselves.

The binder is brought up to temperature first and held there so it flows properly. Filler is then introduced gradually under agitation so that the binder fully wets every particle. Adding filler too quickly leaves dry agglomerates that show up later as weak points in the applied line. Pigment follows, and it must be dispersed completely or the finished marking will show colour variation. Intermix beads go in last and at controlled temperature, because excessive heat or over mixing fractures them and a fractured bead does not retroreflect.

Mixing time and temperature are both recorded. Over processing degrades the binder just as surely as under processing leaves it poorly blended.

Temperature control during blending is the other constant. Holding the melt too hot for too long degrades the binder, which shows up later as a line that becomes brittle sooner than it should. Every batch therefore has a time and temperature envelope rather than simply a target, and staying inside it is a matter of process discipline rather than equipment.

This is where experienced manufacturers of thermoplastic paints separate themselves from operations that simply follow a recipe.

Batch Quality Control Before Release

A batch is not finished when the mixer stops. A sample is drawn and tested against the approved formulation before any of it is packed for despatch.

Softening point confirms that the binder system will hold its shape at road surface temperature rather than tracking under traffic. Whiteness or luminance is measured against the target so the material will pass a colour requirement on site. Bead content is verified, since it cannot be checked once the material is packed. Flow and workability are assessed to confirm the material will lay properly through screed or extrusion equipment at normal application temperature.

Results are recorded against the batch number and retained. If a question arises about material performance two years later, this record is the only thing that can answer it.

Retained samples matter as much as the test results. Keeping a physical sample from each batch means a question raised in eighteen months can be answered by testing the original material rather than by argument. It is inexpensive to do and it is one of the clearest signals that a supplier expects to stand behind what it produces.

Infographic showing the four batch quality control tests run before thermoplastic material is released

What a batch is tested for before it is allowed to leave the plant

What Traceability Gives You on Site

Traceability sounds like paperwork until something goes wrong, at which point it becomes the difference between a resolved problem and an unresolvable argument.

If a section of marking underperforms, a batch record lets you establish whether the material met specification when it left the plant. That single fact separates a material problem from an application problem, and the two have completely different remedies. It also lets a manufacturer reproduce the same formulation for a later phase of the same road, so that markings installed two years apart still match in colour and performance. A trader buying from whichever source is cheapest that quarter cannot offer either guarantee.

Revive Middle East Paints manufactures thermoplastic material at its plant in Emirates Industrial City, Sharjah, and installs it across the Emirates. You can see the projects we have delivered for context.

There is a second, less obvious benefit for a road authority. Consistent formulation across phases means the network ages predictably, which makes a planned remarking programme possible. When material varies from batch to batch, sections installed in the same month start failing at different times and maintenance becomes reactive. Our overview of traffic management services explains how that planning works in practice.

In short, ask three questions of any supplier. Where was this made, what is in it, and can you make it again next year to the same specification. A manufacturer answers all three from records. A trader can usually answer none of them.

Manufacturers of thermoplastic paints who retain batch records can answer a performance question years later, which a trading intermediary cannot.

Conclusion

Manufacturers of thermoplastic paints decide most of what happens on your road long before the material reaches site. Raw material control, blending discipline and honest batch testing are what make one white granular product behave differently from another that looks identical. When you are buying, ask where the material was made, ask for the batch record, and ask whether the supplier can reproduce the same formulation next year. Get in touch to discuss supply for your project.

Road Marking Removal Methods for UAE Contractors

Road marking removal in the UAE gets far less attention than application, and it causes far more lasting damage when it goes wrong. A badly removed line leaves a scar that drivers still read as a marking at night, which is a genuine safety problem rather than a cosmetic one. This article compares the three removal methods used here, explains the damage each one can do, and sets out how to choose without wrecking the surface underneath.

Key Takeaways

  • A ghost marking left after poor removal can still be read by drivers at night, especially in wet conditions.
  • Water jetting is the least damaging method on asphalt. Grinding is the fastest and the most destructive.
  • Removal method should be selected from the substrate and the marking material, not from whatever plant is already on site.

Why Removal Quality Matters More Than Speed

Removing a marking is not simply the reverse of laying one. The material has bonded into the surface texture, and taking it out always takes some of the road with it.

Two problems follow. The first is the ghost marking, a visible outline left where the removed line used to be. It appears because the road under the marking has been shielded from wear, weathering and dust for years, so it is a different colour and texture from its surroundings. At night, and especially in the wet, drivers can still read that outline as a live marking. The second is surface damage. Aggressive removal opens the asphalt, which then ravels, holds water and deteriorates faster than the surrounding surface.

On a live carriageway, both problems are safety issues rather than presentation issues, which is why removal deserves the same specification attention as application.

There is a commercial dimension as well. Damage caused during removal usually falls outside the marking contract and lands with whoever owns the road, which means it is discovered long after the crew has left. Specifying the removal method, and inspecting the surface immediately after removal rather than after reinstatement, keeps responsibility where it belongs.

High Pressure Water Jetting

Water jetting, sometimes called hydro blasting, uses water at very high pressure to break the marking material away from the surface without cutting into it.

It is the gentlest of the three methods on asphalt, because water follows the texture of the road rather than machining a flat plane across it. That makes it the preferred choice on a surface that has to stay in service. It removes thermoplastic and cold plastic effectively, it produces very little ghosting when done properly, and it generates no airborne dust. The trade offs are output rate, the need to manage water and paint residue as a waste stream, and a higher cost per square metre than grinding.

For most permanent works on trafficked UAE roads, water jetting is the method that leaves the road in the best condition.

Pressure and nozzle configuration both need controlling. Too little pressure leaves residue keyed into the texture, which then shows as a patchy ghost. Too much begins to cut into the asphalt matrix and undoes the main advantage of the method. This is operator dependent work, and experience with the particular surface type matters more than the rating of the machine.

Water management is the practical constraint on jetting in the UAE. The residue has to be collected rather than allowed to run into a drainage system, and on a long run that means either a vacuum recovery unit working alongside the jetting head or a containment arrangement that adds time to the operation. Pricing that in at tender avoids an awkward conversation on site.

For asphalt that has to stay in service, water jetting is the road marking removal method that leaves the surface in the best condition.

Infographic comparing water jetting, grinding and shot blasting for road marking removal in the UAE

The three removal methods compared on damage, output and cost

Grinding and Scarifying

Grinding uses rotating cutters or a scarifying head to mill the marking off the surface mechanically, taking a thin layer of the road with it.

It is by far the fastest and cheapest method, and on concrete or on a surface that is about to be resurfaced anyway it is entirely reasonable. On asphalt that has to remain in service it is the most damaging option available. It leaves a milled texture that is clearly visible as a scar, it opens the surface to water ingress and ravelling, and it is very unforgiving of operator error since a moment of excessive depth cannot be undone.

Grinding is best reserved for concrete surfaces, for temporary layouts and for sections programmed for resurfacing shortly afterwards.

Grinding also generates significant airborne dust unless the head is enclosed and extracted, which is a real consideration on live roads and in built up areas across the Emirates. Where the works sit near occupied buildings, that alone can rule the method out regardless of its cost advantage. Dust control obligations normally sit inside the wider traffic management and site safety arrangements for the works.

Shot Blasting

Shot blasting propels steel abrasive at the surface within an enclosed head and recovers both the shot and the debris as it works.

It sits between the other two methods on aggression and on cost. It removes thermoplastic well, it leaves a uniform texture rather than the directional scoring that grinding produces, and the enclosed head controls dust and allows the abrasive to be recycled. It is more aggressive than water jetting and will lightly texture the road surface, which on a sound asphalt is usually acceptable and on a fragile or thin surface is not.

It performs particularly well on concrete and on large open areas such as aprons and yards, where output matters and the substrate can take it.

Recovery of the abrasive is what makes shot blasting practical at scale. The head collects the shot along with the removed material, separates the two and returns the shot to the hopper, so consumption stays low across a large area. That closed loop also keeps the working area much cleaner than open blasting, which matters when the adjacent lane is carrying traffic.

Selecting a road marking removal method from the substrate rather than from the available plant is what prevents long term damage.

Infographic showing four risks to manage during road marking removal in the UAE

The four risks that turn a removal job into a long term road defect

Choosing a Method Without Scarring the Road

The choice should start with two facts. What is the marking made of, and what is it sitting on. Those two answers narrow the options quickly.

Thermoplastic and cold plastic on asphalt that must stay in service point firmly toward water jetting. Any material on concrete tolerates shot blasting or grinding comfortably. Thin cold applied paint often needs far less aggression than crews assume, and over specifying the method causes unnecessary damage. Where the section is due for resurfacing shortly, grinding becomes the sensible economic choice because the scar disappears under the new layer.

Whichever method is selected, plan the reinstatement at the same time. If a new marking is going back in the same place, the removal has effectively become surface preparation and should be treated to that standard. Our road line marking services cover removal and reapplication as a single sequence.

Whatever method is chosen, plan for the ghost. If a marking is being permanently removed rather than replaced, the shielded strip left behind will remain visible for a long time and drivers will read it, particularly at night and in the wet. Surface treatment over the removed line is sometimes the only honest answer, and it needs to be priced at tender rather than discovered afterwards. The principles behind road surface marking visibility apply just as much to a line you are trying to erase.

Removal is also the moment to check the surface beneath. Once the old marking is off, defects that were hidden under it become visible, and repairing them before the new line goes down is far cheaper than reopening the closure later.

Plan road marking removal and reinstatement as a single sequence inside the same closure wherever the programme allows it.

Conclusion

Road marking removal in the UAE deserves the same specification discipline as application, because the consequences of getting it wrong stay on the road for years. Water jetting protects asphalt that has to remain in service. Shot blasting suits concrete and open areas. Grinding is fast and cheap and belongs where the surface is about to be replaced. Choose from the substrate rather than from the plant on site. Contact Revive Middle East Paints to discuss removal and remarking on your network.

Surface Preparation for Road Markings That Do Not Fail

Road marking surface preparation is the least glamorous part of a marking package and the part that decides whether the line survives. When a new marking lifts away in sheets, the material is almost never at fault. Something was left on the road that stopped the bond forming. This article covers the four preparation failures that cause most adhesion problems in the UAE, and what a competent crew does about each of them before any material is heated.

Key Takeaways

  • Most marking failures are substrate failures. A perfect material on a dusty road will still lift away cleanly.
  • Trapped moisture is the failure you cannot see, and it is worst in coastal areas after overnight condensation.
  • Primer must be matched to the substrate. One primer does not suit both concrete and aged asphalt.

Why Most Marking Failures Are Substrate Failures

There is a simple diagnostic when a marking fails early. Look at the underside of the material that came away, and look at the road it came off.

If the marking lifts cleanly and the road beneath is bare, the bond never formed and the cause is preparation. If material has torn and left fragments keyed into the surface, the bond was sound and the material itself was overloaded or wrongly graded. In practice the first pattern is far more common. A thin layer of dust, a film of moisture or a trace of oil acts as a release layer between the hot material and the road, and no amount of material quality compensates for it.

This matters commercially as well as technically, because the two patterns point to completely different parties and completely different remedies.

There is a third pattern worth recognising. If the marking has lifted and taken a thin layer of the road surface with it, the bond was stronger than the road. That points to a weak or friable surface rather than to preparation or material, and the remedy sits with the surfacing rather than with the marking contractor. Identifying which of the three patterns you are looking at takes about a minute on site and settles most disputes.

Cleaning: Sweeping, Blasting and Dust

Cleaning is where most of the preparation effort goes, and in the UAE it has to deal with a dust load that most specifications were never written for.

Mechanical sweeping is the baseline and removes loose debris and the bulk of surface sand. It is rarely sufficient on its own for aged surfaces. Where the road is polished, contaminated or carries old marking residue, abrasive blasting or a mechanical sweep with a wire brush opens the surface and restores texture for the material to key into. Compressed air is used for the final pass immediately before application, because sand blown back across a swept surface by wind or by passing traffic will undo the earlier work within minutes.

The practical rule is that the final clean happens as close to application as the sequence allows, not at the start of the shift.

Old marking residue is a category of its own. A previous line that has been partly removed leaves a patchwork of bonded fragments and bare road, and material laid over that will bond well in some places and not at all in others. The result is a line that fails in patches for no visible reason. Where an old marking is being replaced, the removal has effectively become the surface preparation and needs to meet the same standard.

Thorough road marking surface preparation is the cheapest durability improvement available on any marking package.

Infographic showing six road marking surface preparation checks to complete before application

The six checks that decide whether a marking bonds or lifts

Moisture: The Failure You Cannot See

Moisture is the most damaging contaminant precisely because it leaves no trace a supervisor can point to.

When hot thermoplastic is laid over a damp surface, the trapped water flashes instantly to steam at the interface. That steam has nowhere to go and forces the material away from the road as it forms, producing a bond that looks perfect for weeks and then releases under traffic. Coastal humidity across the Emirates makes this a routine risk, because overnight condensation leaves a film on the surface that is often invisible by first light while the substrate is still holding moisture in its texture.

Competent crews test rather than judge. A simple plastic sheet taped down for a short period will reveal moisture rising out of the surface, and the application window is set from that rather than from the appearance of the road.

Timing the working window around moisture is a planning decision rather than a site decision. On coastal routes the surface may not be reliably dry until well into the morning, which conflicts directly with the desire to work at night when the road is cooler and closures are easier. Resolving that conflict sensibly is one of the genuine skills in programming marking work in the Emirates.

New Asphalt and the Curing Question

Freshly laid asphalt presents the opposite problem. The surface looks ideal, clean and textured, but it is still releasing light oils from the bitumen binder.

Those oils migrate to the surface and interfere with adhesion, and they can also soften the marking material from below over time. This is why permanent markings are normally held back for a curing period after surfacing, and why temporary markings are often used in the interim to keep the road operating. The required period depends on mix design, layer thickness and weather, and in Gulf conditions high surface temperatures both accelerate the release of those oils and increase the risk while they are still present.

Where programme pressure makes waiting impossible, the honest answer is a temporary marking followed by permanent work later, not a permanent marking installed early and hoped for.

The same logic applies to newly laid concrete, which holds mix water for far longer than most programmes assume. Concrete surfaces need both a curing period and mechanical removal of the weak surface layer before any marking is considered. Rushing either step produces a line that lifts cleanly within months.

Primer Selection by Substrate

Primer is not a universal product and using the wrong one is close to using none at all.

Sound, textured asphalt in good condition often needs no primer, because thermoplastic keys mechanically into the surface. Aged, polished or oxidised asphalt has lost that texture and benefits from a primer that penetrates and re establishes a bonding layer. Concrete is a different problem entirely. It is smooth, it is chemically distinct, and it usually carries surface laitance that must be removed mechanically first. Concrete needs a primer formulated for it, and even then many specifiers choose cold plastic instead where loading is heavy.

Application rate and drying time both matter. Over applying primer creates a soft layer that fails under the marking, and marking over primer that has not flashed off traps solvent at the interface. Our material comparison guide covers when to change material rather than persist with primer.

A short verification step protects everything above. Before the crew mobilises, walk the section and confirm the substrate is what the specification assumed. Surfaces change between design and construction more often than anyone expects, and a primer chosen for asphalt that turns out to be laid on a concrete apron will fail regardless of how carefully it is applied.

Where preparation is genuinely impossible within the available window, the honest response is to reprogramme rather than to proceed. A marking installed onto a surface that was not ready will fail, and it will fail after the crew has demobilised and the closure has been surrendered. Our road line marking services are sequenced so that preparation and application sit inside the same closure wherever the programme allows it.

Treat road marking surface preparation as a specified activity with its own hold points, not as something the crew fits in before the real work starts.

Infographic showing road marking primer selection by substrate type

Primer selection and preparation requirement by substrate

Conclusion

Road marking surface preparation costs time rather than money, and it delivers more durability per dirham than any other decision on a marking package. Clean thoroughly and clean late, test for moisture rather than judging it by eye, respect the curing period on new asphalt, and match primer to substrate. Do those four things and the material will do what the specification promised. Speak to our team about preparation requirements on your project.

Why Road Markings Fade Early in the UAE Climate

Road marking durability in the UAE is tested harder than in almost any other market, and markings that would last five years in Europe can be visibly failing here inside two. The causes are well understood but rarely designed for, because specifications are often imported without adjustment. This article works through the four mechanisms that actually destroy a line in Gulf conditions, and sets out what genuinely extends service life rather than what simply sounds reassuring in a tender.

Key Takeaways

  • Asphalt surface temperature, not air temperature, is the figure the material is actually being tested at.
  • Sand acts as a continuous abrasive and also buries beads, which kills night performance before daytime appearance suffers.
  • Most early failures are traceable to surface preparation and binder grade rather than to traffic volume.

Surface Temperature, Not Air Temperature

The single most common specification error in this region is designing around air temperature. Dark asphalt absorbs solar radiation all day and runs substantially hotter than the air above it.

On an exposed carriageway in high summer, the surface a marking is bonded to can hold well above 60 degrees Celsius for hours at a time. Every property of the material is being tested at that temperature. A binder graded for temperate conditions softens, which allows the line to deform under braking, to pick up rubber from tyres and to track in slow moving lanes. The line also expands and contracts against a substrate moving at a different rate, which loads the bond every single day.

Specifying binder grade against realistic surface temperature is the cheapest durability improvement available, and it costs nothing at tender stage.

Thermal cycling compounds the problem. The same surface that runs extremely hot by afternoon cools sharply overnight, particularly in the desert interior where the daily swing is largest. The marking and the road expand and contract at different rates through that cycle, and the interface between them takes the strain every single day. A brittle or poorly bonded line will fail at that interface long before it wears out from traffic.

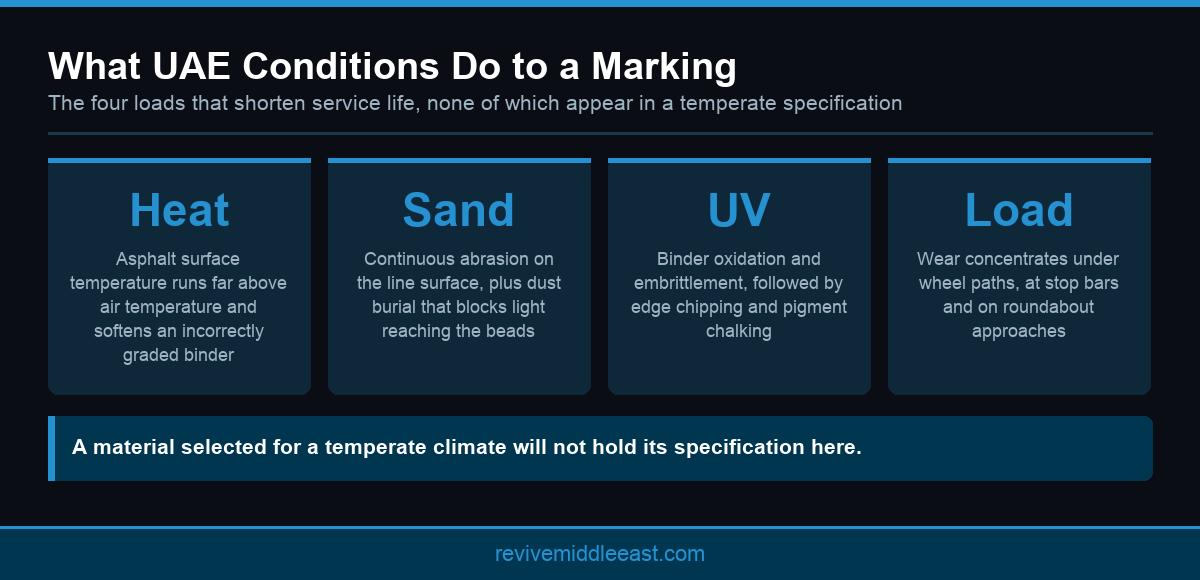

Infographic showing the environmental conditions that reduce road marking durability in the UAE

The four environmental loads acting on a road marking in Gulf conditions

Sand as a Continuous Abrasive

Sand attacks a marking in two separate ways, and only one of them is obvious.

The visible mechanism is abrasion. Fine wind blown particles are dragged across the line surface by every passing vehicle, polishing exposed glass beads and steadily removing material. On desert routes this load is severe enough to cut years off service life compared with a sheltered urban road carrying similar traffic. The less obvious mechanism is burial. Dust settles into the surface texture of the line and blocks light from reaching the beads at all. Night performance can fall dramatically while the marking still looks perfectly white in daylight.

This is why routine mechanical sweeping recovers measurable performance and why markings often appear to improve after rain. Neither restores worn beads, but both remove what is covering them.

The effect is not uniform across the network either. Routes running through open desert take a far heavier abrasive load than urban roads shielded by buildings and landscaping, even where traffic volumes are similar. Treating the whole network as a single maintenance category therefore over serves the sheltered routes and under serves the exposed ones. Segmenting by exposure is one of the cheapest improvements available to an asset manager.

Sand also finds its way into the material during application if the surface was not cleaned late enough. Particles trapped in the film create weak points that begin to break down early, which is a preparation failure that presents itself as premature wear. It is one more reason the final clean belongs immediately before the applicator rather than at the start of the shift.

Sand exposure is the single largest variable in road marking durability across the Emirates road network.

Ultraviolet Exposure and Binder Ageing

Ultraviolet radiation works on the binder system continuously and irreversibly, and its effects appear gradually rather than suddenly.

Prolonged exposure causes the binder to oxidise and embrittle. A brittle line no longer flexes with the substrate underneath it, so thermal movement produces fine cracking, then chipping at the edges, then loss of whole sections. Pigment is affected too. Low quality or under dosed pigment systems yellow and chalk under sustained ultraviolet load, which lowers daytime contrast against the road surface. Chalking also releases the surface binder that was holding the top layer of beads in place.

Ultraviolet stability is a formulation property, decided by the manufacturer and invisible on site. Our article on what happens inside a thermoplastic paint plant explains where those choices are made.

Ultraviolet damage is also cumulative and irreversible, which distinguishes it from dust burial. Sweeping recovers a marking that is merely dirty. Nothing recovers a binder that has already oxidised. This is why a line can look serviceable and then deteriorate very rapidly once the surface layer begins to break down, because the material underneath has been ageing quietly throughout.

Traffic Loading and Where Wear Concentrates

Wear is never evenly distributed across a scheme, which is why average service life is a misleading way to plan maintenance.

Markings under wheel paths take vastly more punishment than edge lines a metre away. Transverse markings such as stop bars and pedestrian crossings sit directly under braking loads, where tyres are both loaded and sliding slightly. Roundabout approaches combine braking with turning, which imposes shear on the bond rather than simple abrasion. Bus stops and taxi ranks concentrate heavy axle loads onto the same few square metres many times a day.

Recognising this at design stage allows selective use of a higher performance material at the stress points, rather than paying for it across the whole layout. Our material comparison article covers where that upgrade is justified.

Vehicle mix matters alongside volume. A route carrying heavy goods traffic imposes far more load per pass than a car dominated road with the same daily count, and industrial areas across the Emirates carry a very high proportion of heavy axles. Design marking life against the vehicle mix rather than the headline traffic figure, or the estimate will be optimistic. Our article on traffic safety on infrastructure projects covers how these loads are assessed.

Planning for road marking durability therefore means designing against the stress points rather than against an average.

Infographic showing where road marking durability failures in the UAE originate

Where early marking failures actually originate, based on typical site investigation findings

What Actually Extends Service Life

Four measures deliver most of the available improvement, and none of them involve buying a more expensive brand of the same product.

Correct surface preparation comes first, because a marking that never bonded properly will fail regardless of material quality. Binder grade matched to real surface temperature comes second. Honest applied film thickness comes third, since a shortfall of half a millimetre is invisible at handover and obvious two years later. Adequate intermix bead content comes fourth, because it lets the line renew its own night performance as the surface abrades.

Beyond those, a planned inspection cycle with retroreflectivity measurement lets you remark on evidence rather than on complaints. Our guidance on surface preparation before marking covers the first and most important of the four.

A short note on measurement is worth adding. Retroreflectivity readings taken at the same locations each time turn a set of numbers into a trend, and a trend lets you forecast when a section will cross the threshold. Readings taken at random points each survey tell you very little. The discipline costs nothing beyond recording chainage properly the first time.

None of these four measures requires a premium product. They require a specification written for this climate and a contractor prepared to follow it, which is a very different proposition from simply paying more per square metre.

Improving road marking durability rarely requires a more expensive product, only a specification written for the conditions it will actually meet.

Conclusion

Road marking durability in the UAE is not a matter of luck or of paying more. Surface temperature, sand abrasion, ultraviolet ageing and concentrated traffic loading are all predictable, and all four can be designed for at specification stage at little or no extra cost. Prepare the surface properly, match binder grade to the real conditions, insist on the specified thickness, and measure performance rather than judging it by eye. Talk to Revive Middle East Paints about extending marking life on your network.

Glass Beads and Retroreflectivity in UAE Road Markings

Reflective thermoplastic road markings in the UAE do their most important work in the hours when nobody is inspecting them. A line that looks perfect at noon can be nearly invisible at 2 am, and the difference has almost nothing to do with the white material itself. It comes down to glass beads, how they are specified, how deep they sit and how quickly Gulf conditions take them away. This article explains how that system works and how to hold a contractor to it.

Key Takeaways

  • Night visibility comes from glass beads acting as lenses, not from the whiteness of the marking material.
  • Embedment depth of roughly half the bead diameter is the target. Too deep and the bead gathers no light. Too shallow and traffic removes it.
  • Retroreflectivity should be specified twice, once at handover and once as a maintained minimum through the defects period.

How a Glass Bead Actually Returns Light

A glass bead embedded in a road marking behaves as a small spherical lens. Headlight beams enter the exposed surface of the bead, refract as they pass through the glass, reflect off the pigmented material behind it, and leave along approximately the path they arrived on.

That behaviour is called retroreflection, and it explains a familiar effect. The marking looks brilliant to the driver whose own headlights are illuminating it, while looking dull to somebody standing at the roadside. The light is being sent back to its source rather than scattered evenly. It also explains why a marking loses all its night performance the moment the beads are gone, even though the white line is still clearly there in daylight.

Bead quality decides how efficiently this happens. Irregular, fractured or cloudy particles do not focus light properly and contribute almost nothing.

This also explains a common misunderstanding on site. A supervisor who inspects a new marking in daylight and pronounces it excellent has verified the colour and the geometry and nothing about the property that matters after dark. Night performance has to be measured with an instrument or inspected at night. There is no way to see it at noon.

What RL Means and How It Is Measured

Retroreflectivity is quoted as an RL value in millicandelas per square metre per lux. In plain terms, it measures how much light comes back to the driver eye for a given amount of light going out. Higher numbers mean a brighter line at night.

European practice under BS EN 1436 groups performance into classes, with each class setting a minimum RL value that the marking must meet. Measurement is done with a retroreflectometer, either as a handheld unit walked along the line or as a mobile unit mounted on a vehicle. The critical point is where readings are taken. A single reading at a convenient location proves nothing. Readings should be taken at intervals along the run and reported with their chainage.

Specify two values. An initial value demonstrated at handover, and a maintained minimum that must still be met later in the defects period. Only the second obliges the contractor to have used decent beads.

Where readings are taken matters as much as the value itself. Retroreflectivity varies along a run because bead placement varies, and a contractor selecting the measurement location will naturally select a good one. Specify that readings are taken at fixed intervals, that each is reported with its chainage, and that the assessment uses the average and the lowest reading rather than the best.

Infographic showing how retroreflectivity of thermoplastic road markings declines over time in UAE conditions

Indicative pattern of retroreflectivity decline, showing why measurement beats visual inspection

Embedment Depth: The Number Nobody Specifies

Embedment is how far the bead sits into the marking material. It is rarely written into a specification and it is one of the most common reasons a new line underperforms from day one.

If a bead is pressed in too deep, very little of its surface is exposed and it cannot gather enough light to retroreflect. If it barely touches the surface, there is not enough material gripping it and traffic will sweep it away within days. The working target sits at roughly half to sixty per cent of the bead diameter below the surface. Achieving that is a matter of timing. Beads must land while the thermoplastic is still hot enough to accept them and cool enough to hold them.

This is why bead application is fixed immediately behind the applicator rather than treated as a separate pass. It is also why a crew that is running behind schedule tends to produce markings with poor night performance.

Application temperature is the lever that controls embedment, and it moves quickly. Material that has cooled slightly before the beads land will hold them too shallow. Material that is still too hot lets them sink out of reach. This is why bead dispensers are fixed to the applicator rather than run as a separate operation, and why a crew rushing to finish before handback tends to produce a line that measures poorly on its first night.

Reflective thermoplastic road markings only perform when the beads sit at the right depth, which makes embedment a specification issue rather than a site detail.

Intermix Beads Compared With Drop On Beads

Two different bead populations work in a thermoplastic marking, and they do different jobs at different points in the life of the line.

Drop on beads are applied to the hot surface at the moment of laying. They sit at the top of the film and they provide all of the retroreflectivity you measure at handover. Intermix beads are blended through the material during manufacture. They contribute nothing on day one, because they are buried. Their role begins as the surface wears down and exposes fresh beads that have been waiting inside the film. In effect the marking regenerates its own night performance as it abrades.

A material with no intermix beads will show a sharp drop in performance once the drop on layer is gone. It is worth confirming the intermix content when you buy, because it is invisible on site and easy to leave out.

Specifying intermix content is straightforward once you know to ask. State a minimum percentage by weight in the material specification and require the batch record to confirm it. Because the beads are inside the product rather than on it, this is one of the few quality attributes that genuinely cannot be checked on site, which makes the paperwork the only control available to you.

Infographic showing six quality checks for glass beads in reflective thermoplastic road markings

The bead properties worth writing into a specification

Why Retroreflectivity Falls Faster in the Gulf

Two local conditions attack bead performance in ways that temperate specifications never account for, and both act well before the marking itself wears out.

The first is sand. Fine wind blown particles polish the exposed bead surfaces and, worse, settle into the texture of the line. A layer of dust across the beads blocks light from entering them at all, which is why a marking can recover measurably after rain or after mechanical sweeping. The second is surface temperature. A binder that softens in the heat allows beads to sink further into the film over time, quietly moving them past the useful embedment depth without any wear taking place.

Both effects mean night performance in the UAE should be measured rather than assumed. The related mechanisms behind material ageing are covered in our article on why road markings fade early here.

There is a maintenance opportunity in this that most networks miss. Because dust burial is reversible and bead wear is not, a scheduled mechanical sweep on exposed routes recovers real performance at a fraction of the cost of remarking. Building sweeping into the maintenance cycle can extend the useful life of the road line marking asset by a meaningful margin before reapplication becomes necessary.

Reflective thermoplastic road markings therefore need periodic measurement in this region rather than an assumption that they are still working.

Conclusion

Reflective thermoplastic road markings in the UAE succeed or fail on the quality of a system most specifications barely mention. Beads must be well formed, correctly graded and embedded to the right depth, and there must be intermix material waiting inside the film for the years after the surface layer has gone. Specify an initial and a maintained RL value, measure along the run, and treat night performance as something you check rather than something you hope for. Contact our team to discuss retroreflectivity requirements on your project.

Thermoplastic vs Cold Paint vs MMA for UAE Roads

Choosing a thermoplastic paint road marking over cold applied paint or MMA cold plastic is one of the earliest decisions on a road package, and it is regularly made on price alone. That is a mistake in the UAE, because the three materials behave very differently once surface temperatures climb and sand starts working on the line. This article sets the three families side by side and gives you a way to choose based on traffic volume, substrate and how long the layout needs to last.

Key Takeaways

  • Cold paint is the cheapest to install and the most expensive to maintain on any road carrying real traffic.
  • Thermoplastic is the default for UAE carriageways because it combines depth of material with a set time short enough for night closures.
  • MMA earns its premium on concrete and on high stress areas, not across a whole scheme.

The Three Material Families at a Glance

Permanent road marking in the UAE is dominated by three material families, and they differ in how they set rather than in what they look like. Cold applied paint dries by evaporation. Thermoplastic solidifies by cooling from a melt. MMA cold plastic cures through a chemical reaction between a resin and a hardener.

That difference in setting mechanism drives everything else. A material that dries by evaporation loses most of its wet volume, so a coat laid at half a millimetre wet finishes far thinner. A material that solidifies by cooling loses almost nothing, so specified thickness and delivered thickness stay close. A material that cures chemically forms a bond with the substrate rather than simply sitting on it, which is why it holds on surfaces where the others struggle.

Understanding those three mechanisms is enough to predict most of the performance differences you will see on site. Everything in the sections below follows from them.

One practical consequence is worth stating early. Because cold paint loses most of its wet volume as it dries, the figure quoted in a specification and the figure left on the road are two different things. Thermoplastic and cold plastic both keep almost all of what is laid. When you compare a paint thickness against a thermoplastic thickness you are not comparing like with like, and the gap in delivered material is wider than the numbers suggest.

Infographic comparing thermoplastic paint road marking with cold applied paint and MMA cold plastic

The three material families compared on the properties that decide performance

Cold Applied Paint: Cheap, Fast and Short Lived

Cold applied paint arrives ready to use and goes down through a spray unit at roughly 0.3 to 0.5 mm wet. It is the fastest material to mobilise, it needs the least equipment, and its rate per square metre is unmatched. On a car park or a temporary layout it is often exactly the right answer.

On a trafficked carriageway in this climate the picture changes quickly. Once the solvent or water has left the film there is very little material holding the beads or resisting abrasion. Wind blown sand removes the surface within months, and the line loses night time performance long before it looks worn in daylight. Repainting then carries its own traffic management cost, which is frequently larger than the paint itself.

Cold paint keeps a genuine role wherever the marking is meant to change. Car park bay layouts, phased diversions and trial arrangements all favour a material that is cheap to install and easy to remove.

Removal cost belongs in the comparison too. Thin paint comes off easily, which is exactly why it suits layouts that will change. A thermoplastic line laid in the wrong place has to be taken off with water jetting or blasting, and that work is slower, more expensive and carries a risk of marking the road surface. Our guide to road marking removal covers what each material demands.

Thermoplastic: The Default for UAE Carriageways

Thermoplastic is supplied as a granular solid, heated on site and laid hot at roughly 2 to 3 mm. That depth of material is the whole point. It carries intermix beads through its full thickness, so fresh reflective surfaces keep being exposed as the line wears down.

The second advantage is set time. A thermoplastic line cools and hardens in well under three minutes, which means a lane can be reopened almost immediately. On UAE roads, where most marking work happens inside a night time closure with a fixed handback time, that property is worth as much as the durability. Binder grade still needs attention, because a formulation intended for a temperate climate will soften and track at Gulf surface temperatures.

For highways, main roads, junctions and any layout expected to stay put, thermoplastic is the sensible default. Our complete guide to thermoplastic road markings covers the specification detail behind that choice.

Binder grade is the detail that decides whether thermoplastic performs as intended here, and it never appears on a delivery note. Two bags of white granules from different sources can behave completely differently once the road surface passes 60 degrees. Asking a supplier which grade they are providing, and asking for the batch record that supports it, separates a manufacturer from a trader within about two questions.

For most UAE carriageway work, a thermoplastic paint road marking is the specification that balances installed cost against the number of closures the road will need over its life.

MMA Cold Plastic: Where the Premium Is Justified

Methyl methacrylate cold plastic cures by reaction rather than by cooling or drying. The result is a marking that chemically keys into the surface, resists deformation under braking and turning loads, and performs reliably on concrete where thermoplastic adhesion can be inconsistent.

The trade offs are cost and site discipline. MMA is considerably more expensive per square metre, it must be mixed accurately on site, and it has a working window that punishes delay. It is also unforgiving of poor preparation, although in fairness so is everything else. Most schemes use it selectively rather than universally.

The places it usually earns its price are roundabout approaches, pedestrian crossings, bus stop boxes, concrete aprons and any location where vehicles brake, turn or stand repeatedly on the same piece of marking.

Site discipline is the practical limit on MMA. The resin and hardener must be mixed in the correct proportion and used within a working window that shortens as the temperature rises. In UAE summer conditions that window can be very short indeed, which makes MMA a material for planned, well supervised work rather than for improvised repairs at the end of a shift.

Choosing by Traffic Volume and Substrate

A workable decision rule starts with two questions. How much traffic will cross this marking, and what is it being laid onto. Traffic volume sets the minimum material depth you need. Substrate decides whether adhesion will be straightforward or will need help.

On asphalt carrying heavy traffic, thermoplastic is the working answer, with MMA reserved for the stress points within the same scheme. On concrete, MMA moves from optional to preferred, and thermoplastic needs a properly matched primer and mechanical preparation to compete. On interior floors, in car parks and in any layout that will be revised within a year or two, cold paint is both cheaper and easier to remove later.

One more factor belongs in the decision. If the marking sits inside a live carriageway, set time affects the cost of every future intervention. Choose the material that lets you hand the lane back quickly, and you reduce the cost of every remarking cycle for the life of the road. Our road line marking service page sets out how these choices apply by site type.

Programme should influence the decision as much as engineering does. If the road is due for resurfacing within two years, spending on a marking designed to last six is money that will be milled away. Equally, choosing cold paint on a carriageway that will not be touched for a decade guarantees repeated closures that each cost more than the material being installed. Match the marking life to the surfacing life and most of the decision makes itself.

Where the layout is permanent and the traffic is heavy, a thermoplastic paint road marking remains the sensible default.

Infographic showing which road marking material suits each site type in the UAE

A working selection guide by site type and substrate

Conclusion

There is no single best road marking material, only a best fit for the traffic, the substrate and the intended life of the layout. Cold paint suits temporary and low wear work. A thermoplastic paint road marking suits almost everything on a public carriageway in the UAE. MMA earns its cost at the stress points. Get the match right at specification stage and you avoid the far larger cost of remarking early. Speak to Revive Middle East Paints about the right material for your scheme.

Safety Equipment: Essential Solutions for Road Safety, Traffic Management, and Construction Projects

Safety equipment is the foundation of every well-managed road, traffic system, and construction site. In the UAE, where infrastructure development moves at a rapid pace, the demand for reliable road safety equipment has never been greater. From high-traffic urban corridors to large-scale construction zones, having the right tools and products in place can mean the difference between order and chaos, or worse, preventable accidents. This blog explores the essential categories of safety equipment, their applications, and why selecting the right supplier matters for long-term project success.

Key Takeaways

  • Safety equipment is critical for protecting road users, workers, and infrastructure across the UAE.
  • Traffic safety equipment such as guard rails, road signs, and road markings are core components of any effective traffic management system.
  • Choosing a qualified manufacturer and installer ensures compliance, durability, and long-term performance on every project.

What Is Safety Equipment and Why Does It Matter?

Safety equipment refers to any product, system, or device designed to protect people and infrastructure from harm. In road and traffic contexts, this includes physical barriers, signage, road markings, lighting structures, and more. These products work together to create environments where drivers, pedestrians, and workers can operate with a reduced risk of injury.

In the UAE, rapid urban expansion and large-scale infrastructure projects have made road safety equipment a national priority. Authorities and contractors are increasingly required to meet strict standards for road design, construction zone protection, and traffic control. Without proper safety systems, projects face regulatory delays, liability risks, and higher incident rates. To understand how traffic safety equipment directly reduces accidents, visit how traffic safety equipment helps reduce accidents and improve road safety.

Core Categories of Road Safety Equipment

Road safety equipment is not a single product. It is an integrated system of tools and structures, each serving a specific function. Understanding these categories helps project managers, contractors, and government authorities make informed procurement decisions.

Traffic Signs and Road Signage

Traffic signs are among the most visible forms of safety equipment on any road network. They communicate speed limits, hazard warnings, directional guidance, and regulatory instructions to drivers. Properly designed and installed signs reduce driver confusion and help maintain traffic flow. In construction zones, temporary signage is equally important to redirect vehicles safely around active work areas. Revive Middle East manufactures and supplies a wide range of road signage solutions tailored to UAE infrastructure requirements.

Sign placement, reflectivity, and material quality all play a role in effectiveness. Signs that are poorly positioned or made from substandard materials lose their communicative value quickly, especially in the UAE’s intense sunlight and sandstorm conditions. Contractors and authorities should always source signage from manufacturers who understand local environmental demands. For a deeper look at installation best practices, refer to key factors to consider when installing traffic signs.

Guard Rails and Safety Barriers

Guard rails and safety barriers are physical structures that prevent vehicles from crossing into oncoming lanes, off-road areas, or pedestrian zones. They are among the most critical components of road safety equipment on highways, bridges, and construction sites. When installed correctly, they absorb and redirect impact energy, significantly reducing the severity of accidents.

In industrial and commercial facilities, safety barriers serve a dual purpose: protecting infrastructure assets and managing vehicle movement within confined spaces. Revive Middle East supplies guard rails and barrier systems built to withstand the conditions typical of UAE roads and project sites. For more information on barrier applications in commercial settings, see road safety barriers for industrial and commercial facilities.

Road Line Marking

Road line marking is a foundational element of traffic management. Painted or thermoplastic markings on road surfaces define lanes, pedestrian crossings, stop lines, parking zones, and directional arrows. Without clear markings, drivers struggle to interpret road layouts, especially in complex intersections or multi-lane roads.

In the UAE, thermoplastic road marking materials are widely preferred due to their durability and high visibility under harsh weather conditions. Traffic safety equipment that includes quality road markings contributes directly to accident prevention and smoother traffic flow. Revive Middle East offers professional road line marking services using materials designed for long-lasting performance in extreme heat. The use of quality thermoplastic paint ensures markings remain visible and effective across the full project lifespan.

Street Lamp Poles and Road Furniture

Adequate lighting is a safety requirement, not an aesthetic one. Street lamp poles along highways, intersections, and construction zones ensure that road users can see clearly during nighttime conditions. Poor lighting is a contributing factor in a significant number of nighttime road incidents.

Road furniture, which includes items like bollards, rumble strips, delineators, and channel markers, helps guide traffic and signal changes in road conditions. These items work as part of a broader safety equipment system, reinforcing the messages communicated by signs and markings. Selecting road furniture that meets UAE specifications is essential for durability and compliance.

Safety Equipment for Construction Project Zones

Construction zones present unique safety challenges. Active worksites exist alongside live traffic, creating hazard exposure for both workers and road users. Effective traffic safety equipment in these environments must account for changing site conditions, shifting work boundaries, and diverse road user types.

Key safety equipment used in construction zones includes temporary barriers, cones, warning signs, delineators, and reflective gear. These products must be set up in accordance with local traffic management plans approved by relevant authorities. Compliance with UAE safety standards is not optional. It is a legal requirement for contractors operating on public roads or near public infrastructure. For a comprehensive overview of the standards contractors must follow, refer to safety equipment standards every UAE contractor should know.

The International Road Federation consistently highlights that standardized safety measures in construction zones reduce worker fatalities and public road incidents by a measurable margin. Planning these zones with appropriate equipment is not just good practice. It is a professional and legal obligation.

How to Choose the Right Safety Equipment Supplier in the UAE

Not all suppliers offer the same level of product quality, compliance assurance, or after-service support. When selecting a supplier for road safety equipment in the UAE, consider the following criteria.

  • Manufacturing capability: Does the supplier produce their own products or resell imported goods? Local manufacturing often means faster delivery and the ability to customize products for specific project needs.
  • Compliance knowledge: Does the supplier understand UAE regulatory requirements and design products accordingly?
  • Installation services: Can the supplier handle professional installation, or will you need to coordinate a separate contractor?
  • After-service support: Are maintenance and replacement services available after initial installation?
  • Project experience: Has the supplier successfully delivered products for comparable infrastructure projects?

Revive Middle East checks all of these boxes. As a UAE-based manufacturer and supplier, the company provides end-to-end solutions covering production, supply, installation, and ongoing service support. Their portfolio spans government infrastructure projects, commercial developments, and industrial facilities. Explore the full range of offerings on the products page.

The Role of Traffic Management in Road Safety

Effective traffic management is inseparable from safety equipment. Systems that regulate vehicle flow, warn of hazards, and delineate road boundaries collectively reduce congestion, conflict points, and accident risk. This is why infrastructure planners treat traffic management as a discipline rather than a checklist item.

In the UAE, municipalities and road authorities work closely with certified suppliers to design and implement traffic management systems that meet national standards. The integration of signs, markings, barriers, and lighting into a unified plan is what makes roads genuinely safer. According to the World Health Organization, road traffic injuries remain a leading cause of death globally, and infrastructure-based interventions are among the most effective prevention strategies available.

For project managers and contractors, understanding the full scope of traffic safety equipment requirements before a project begins helps avoid costly retrofits and regulatory penalties later. Working with an experienced partner from the outset is always the smarter investment.

Conclusion

Safety equipment is not a commodity purchase. It is a critical investment in public protection, regulatory compliance, and project success. Whether you are managing a highway expansion, setting up a construction zone, or upgrading traffic infrastructure in a commercial development, the quality and suitability of your road safety equipment will determine outcomes for years to come. Revive Middle East offers UAE-based manufacturing, supply, and installation services across the full spectrum of traffic and road safety products. Contact the team today to discuss your project requirements and find solutions built for the UAE environment.

Frequently Asked Questions

What types of safety equipment are used in road construction zones?

Road construction zones typically require temporary barriers, cones, delineators, warning signs, and reflective gear. These products protect both workers and road users from hazards caused by active construction activities. Proper setup must follow approved traffic management plans aligned with UAE regulatory requirements.

Why is thermoplastic paint preferred for road line marking in the UAE?

Thermoplastic paint is preferred because it offers superior durability and high visibility in extreme heat and sandstorm conditions common across the UAE. It bonds firmly to road surfaces and maintains its reflective properties far longer than standard road paint, reducing maintenance costs over time.

How do guard rails improve highway safety?

Guard rails act as physical barriers that absorb and redirect vehicle impact energy during collisions. They prevent vehicles from crossing into oncoming lanes or leaving the road entirely. When correctly installed, they significantly reduce the severity of accidents on highways, bridges, and sharp curves.

What is the difference between road safety equipment and traffic safety equipment?

Road safety equipment refers broadly to all products protecting road users and infrastructure, including barriers and lighting. Traffic safety equipment focuses specifically on tools that regulate and guide vehicle flow, such as signs, road markings, and lane delineators. Both categories overlap and work together in practice.

How do I ensure my construction site meets UAE safety equipment standards?

Contractors should review the safety equipment standards every UAE contractor should know before starting any project near public roads. Sourcing compliant products from a certified local manufacturer like Revive Middle East also helps ensure your site meets all regulatory requirements.

What role does road signage play in traffic management?

Road signage communicates critical information to drivers, including speed limits, hazard warnings, and directional guidance. In traffic management systems, signs are the primary tool for regulating driver behavior. Well-designed and correctly positioned signage reduces confusion, prevents accidents, and maintains smooth traffic flow on all road types.

Can safety barriers be used in commercial and industrial facilities?

Yes, safety barriers are widely used in warehouses, parking structures, and industrial sites to manage vehicle movement and protect infrastructure. They prevent accidental damage to walls, equipment, and pedestrian zones. Revive Middle East supplies barrier systems suited for both road and facility applications across the UAE.

How often should road line markings be maintained or replaced?

Road line markings should be inspected regularly, typically every 12 to 24 months depending on traffic volume and environmental conditions. Faded or damaged markings reduce driver guidance and increase accident risk. Using quality thermoplastic materials extends marking lifespan, as detailed in guidance on the importance of clear road line marking in high traffic areas.

What factors affect the durability of road safety equipment in the UAE?

Key factors include material quality, UV resistance, heat tolerance, and installation precision. The UAE climate features extreme temperatures, sand abrasion, and intense sunlight that degrade inferior materials quickly. Selecting products manufactured specifically for these conditions and installed by experienced professionals extends equipment lifespan considerably.

Does Revive Middle East handle both supply and installation of safety equipment?

Yes, Revive Middle East provides end-to-end services covering manufacturing, supply, professional installation, and after-service support. Clients managing complex infrastructure work can explore completed examples through the our projects portfolio, which demonstrates the full scope of road and traffic safety solutions delivered across the UAE.

How Traffic Safety Solutions Support Large Infrastructure and Civil Engineering Projects

Traffic safety solutions are at the core of every successful large infrastructure and civil engineering project. From the earliest groundbreaking phase to the final handover, managing the movement of vehicles, workers, and pedestrians around active construction zones is a critical responsibility. Without a structured approach to road safety, even well-funded projects face costly delays, regulatory penalties, and serious risk to human life. This blog explores how purpose-built traffic safety systems protect project sites, keep roads functional, and support project delivery at scale.

Key Takeaways

  • Traffic safety solutions are essential at every stage of large infrastructure and civil engineering projects to protect workers and the public.
  • Products like guard rails, road markings, traffic signs, and road gantries each play a distinct role in maintaining road safety around active construction zones.
  • Partnering with a trusted road safety solutions provider in the UAE ensures regulatory alignment and long-term infrastructure performance.

Why Traffic Safety Solutions Are Critical for Civil Engineering Projects

Civil engineering projects fundamentally alter traffic patterns. Road widening, bridge construction, utility pipeline installation, and highway interchanges all require controlled access zones, clear signage, and physical barriers. A lapse in any of these can result in vehicle intrusions, worker injuries, or public accidents.

According to the International Transport Forum, construction zones are among the highest-risk environments for road users and workers globally. In the UAE, where infrastructure development is rapidly expanding, having a reliable road safety solutions provider is not optional. It is a regulatory and operational necessity.

Effective traffic safety solutions serve multiple purposes. They redirect live traffic away from hazard zones, communicate construction boundaries to drivers, and protect workers operating in close proximity to moving vehicles. Projects that invest in comprehensive traffic management systems are better positioned to meet compliance standards and avoid project stoppages.

Key Traffic Safety Products Used in Large Infrastructure Projects

Understanding the specific products that contribute to road safety helps project managers and contractors make informed procurement decisions. Each product category addresses a different dimension of site safety.

Guard Rails and Physical Barriers

Guard rails are among the most critical components of any large-scale construction traffic management plan. They physically separate construction zones from live traffic lanes, preventing unauthorized vehicle entry and protecting construction personnel.

In civil engineering projects involving elevated structures, highway upgrades, or tunneling, guard rails serve as both safety barriers and legal demarcations. Traffic safety equipment like guard rails must meet material durability standards suited to UAE climate conditions, including high heat tolerance and resistance to salt-laden air near coastal developments.

Road Markings for Construction Zone Visibility

Temporary and permanent road markings are essential tools for guiding drivers through or around active construction sites. Lane shifts, detour routes, reduced speed zones, and pedestrian crossings all depend on clearly visible road markings.

Thermoplastic road markings are especially effective in high-traffic construction environments because of their durability and retroreflective properties. Thermoplastic road markings improve visibility significantly during night operations and in adverse weather, both common challenges on large infrastructure sites in the UAE. Properly applied markings reduce confusion for drivers approaching altered road configurations.

Traffic Signs and Regulatory Compliance

Traffic signs communicate the rules of engagement to every road user approaching a construction zone. Speed limit reductions, directional changes, hazard warnings, and worker-presence signs are all regulatory requirements under UAE road safety standards.

A qualified road safety solutions provider manufactures signs that comply with local transport authority specifications. Custom signage for specific project conditions, such as restricted hours of construction activity or lane closures on multi-level interchanges, ensures both legal compliance and effective communication to the public. Poorly designed or non-compliant signs expose contractors to liability.

Road Gantries and Overhead Structures

On large highway or expressway infrastructure projects, road gantries play a vital role. These overhead frameworks support signage, lighting, and electronic information displays above live traffic lanes.

Gantries are particularly valuable when ground-level signage is insufficient due to high vehicle speeds or restricted roadway widths. For civil engineering projects involving smart highway components or variable message systems, gantries serve as the structural backbone for intelligent traffic management. Proper installation and structural integrity are essential for long-term performance and public safety.

Streetlamp Poles and Site Illumination

Adequate lighting is a fundamental requirement for safety during nighttime construction phases. Streetlamp poles positioned around active work zones ensure that both workers and road users can operate with clear visibility.

On infrastructure projects that run 24-hour shifts, which are common in UAE government-priority developments, site illumination directly affects both worker safety and the safety of passing motorists. A road safety solutions provider that also supplies streetlamp poles and related road furniture offers project managers a streamlined procurement channel for all site safety infrastructure.

How Traffic Safety Solutions Support Project Phasing

Large civil engineering projects are not completed in a single phase. They progress through site preparation, foundation works, structural construction, and final commissioning. Each phase introduces different traffic safety requirements.

During early site preparation, temporary barriers and signage establish the construction perimeter. As the project advances, road markings are updated to reflect evolving detour routes and access points. In final phases, permanent road markings, signs, and guard rails are installed to meet long-term infrastructure standards.

A coordinated road safety plan that anticipates phased requirements avoids last-minute procurement gaps, reduces downtime, and ensures that every stage of the project maintains full compliance with UAE traffic authority regulations. Working with a manufacturer that offers both supply and installation services simplifies this coordination significantly.

For insight into how common traffic management challenges arise and how they can be addressed systematically, understanding traffic management challenges provides valuable context for project planners.

The Role of a Road Safety Solutions Provider in UAE Infrastructure Projects

Selecting the right road safety solutions provider is a strategic decision that affects project safety, compliance, and delivery timelines. In the UAE, infrastructure projects are subject to rigorous oversight by municipalities, road and transport authorities, and federal safety regulators.

A capable provider brings several advantages to large-scale projects. These include:

  • Manufacturing capacity for large-volume orders of signs, barriers, and road furniture
  • Technical expertise in product specification and compliance with UAE standards
  • Professional installation teams with experience on civil and highway projects
  • After-service support for maintenance, replacement, and periodic inspection
  • Ability to supply custom products for project-specific requirements

Revive Middle East manufactures and supplies a comprehensive range of traffic safety solutions for the UAE market. With product lines covering traffic signs, road gantries, guard rails, streetlamp poles, aluminum railings, road furniture, and road markings, the company is positioned to support infrastructure projects across all phases. Explore the full range of services available for infrastructure and civil engineering projects in the UAE.

Road safety on construction sites also requires ongoing compliance with evolving industry benchmarks. Contractors and project managers can review safety equipment standards every UAE contractor should know to stay aligned with current regulations.

Conclusion

Traffic safety solutions are not an afterthought on large infrastructure and civil engineering projects. They are an integrated operational requirement that touches every phase of project delivery. From guard rails and road markings to traffic signs and road gantries, each product plays a defined role in protecting lives, maintaining traffic flow, and ensuring regulatory compliance. Partnering with an experienced road safety solutions provider in the UAE gives project teams the supply chain reliability and technical expertise needed to meet the highest standards of road safety. Contact Revive Middle East to discuss your project’s traffic safety requirements and explore tailored solutions for your next infrastructure development.

Frequently Asked Questions

What are traffic safety solutions used for in construction projects?

Traffic safety solutions manage vehicle and pedestrian movement around active construction zones. They include guard rails, road markings, traffic signs, and barriers that protect workers and road users while keeping surrounding road networks functional throughout each project phase.

Why is road safety planning important for civil engineering projects?

Road safety planning prevents accidents, reduces project delays, and ensures legal compliance with UAE transport authority regulations. A structured plan identifies the right products for each construction phase, from temporary signage to permanent barriers, supporting safe project delivery from start to finish.

What types of road markings are used in construction zones?

Construction zones use both temporary and permanent road markings. Thermoplastic markings are preferred for their durability and retroreflectivity. They clearly indicate lane shifts, detour paths, and speed changes. Quality road markings are critical for traffic safety and must remain visible in all lighting conditions.

How do guard rails contribute to infrastructure project safety?

Guard rails physically separate live traffic from active construction areas. They prevent unauthorized vehicle intrusions, protect workers, and serve as legal site demarcations. On highway and elevated structure projects, guard rails are mandatory safety components that must meet material durability and climate resistance standards.

What qualifications should a road safety solutions provider have in the UAE?

A qualified road safety solutions provider should have manufacturing capability, technical compliance knowledge, professional installation teams, and after-service support. They must understand UAE municipality and transport authority standards. Experience with large infrastructure and civil engineering projects is essential for reliable product delivery and on-site implementation.

How are road gantries used in large highway projects?

Road gantries are overhead structures that support signage, lighting, and variable message systems above high-speed traffic lanes. They are used when ground-level signs are insufficient due to road width or vehicle speed. Gantries are integral to smart highway systems and require precise structural installation for long-term safety.

How often should traffic safety equipment be inspected on construction sites?

Traffic safety equipment should be inspected regularly throughout the project. High-traffic zones may require daily checks, while lower-risk perimeter areas may need weekly reviews. Damaged signs, faded markings, or displaced barriers should be repaired immediately to maintain consistent clear road line marking in high-traffic areas.

Can traffic safety products be customized for specific project requirements?

Yes, traffic safety products can be customized to meet project-specific needs. Custom signage, non-standard barrier configurations, and project-specific road markings can be manufactured to comply with UAE regulations. Working with a manufacturer that offers custom production ensures every site condition is addressed with precision and regulatory accuracy.

What role does streetlamp pole installation play in nighttime construction safety?

Streetlamp poles provide essential illumination for nighttime construction phases. Proper lighting allows workers to operate safely and helps drivers navigate altered road configurations. On UAE infrastructure projects that run around the clock, adequate site lighting is a direct contributor to reducing worker incidents and motorist confusion near active zones.

How do traffic safety solutions change across different project phases?

Traffic safety requirements evolve with each project phase. Early stages need temporary barriers and signage to define site perimeters. Mid-project phases require updated road markings for detours. Final phases involve permanent installation of signs and barriers. Road signage must be updated consistently to reflect changing site conditions and access points.

Construction Site Safety Signage: Essential Requirements Every Contractor Should Know

Construction site safety signage is one of the most critical elements of any construction project in the UAE. Whether you are managing a large-scale infrastructure development or a mid-size commercial build, the right signage keeps workers safe, guides the public away from hazards, and ensures full regulatory compliance. This blog breaks down the essential signage requirements every contractor must understand, from mandatory sign types to placement standards and the road safety products that support them.

Key Takeaways

  • Construction site safety signage is a legal requirement in the UAE and must meet specific standards for visibility, placement, and content.
  • Using the right road safety equipment alongside proper signage reduces on-site accidents and protects both workers and road users.
  • Contractors must regularly audit signage conditions to ensure signs remain visible, intact, and compliant throughout the project lifecycle.

Why Construction Site Safety Signage Matters in the UAE

Construction zones are among the most hazardous environments in any urban setting. In the UAE, where large-scale infrastructure projects are ongoing across multiple Emirates, the risk of accidents near active work zones is significant. Construction site safety signage plays a direct role in controlling that risk by communicating warnings, instructions, and hazard alerts to workers and the general public.

According to guidelines from the UAE Ministry of Human Resources and Emiratisation, employers in the construction sector are required to display clearly visible safety notices at all access points and high-risk zones. Non-compliance can result in project delays, fines, and heightened liability in the event of an accident.

Beyond legal obligations, proper signage builds a culture of safety on site. When workers see consistent, well-maintained signs, they are more likely to follow safe practices. Contractors who invest in quality road safety products signal their commitment to both worker welfare and professional standards.

Types of Construction Site Safety Signs You Must Have

Not all signs serve the same purpose. Construction sites require a mix of sign categories, each communicating a different type of instruction or warning. Understanding these categories is the first step toward building a compliant and effective signage plan.

Mandatory Signs

Mandatory signs instruct workers and visitors to take a specific action. Common examples include ‘Hard Hat Area,’ ‘High Visibility Vest Required,’ and ‘Authorized Personnel Only.’ These signs are typically displayed in white text on a blue circular background. Their placement at entry points and near specific work zones ensures that safety rules are communicated before anyone enters a hazardous area.

Warning and Hazard Signs

Warning signs alert people to potential dangers. On a construction site, these may include signs for falling objects, electrical hazards, deep excavations, or heavy machinery operation zones. These signs generally follow a yellow or amber color with a black pictogram. Positioning them at eye level and at adequate distances from the hazard is essential to give workers and bystanders sufficient time to react.

Prohibition Signs

Prohibition signs tell people what they must NOT do in a specific area. ‘No Smoking,’ ‘No Entry,’ and ‘No Unauthorized Vehicles’ are standard examples. These signs use a red circle with a diagonal line over the prohibited action. Placing them at all relevant entry points and along perimeter fences ensures visibility from multiple approach directions.

Emergency and Safety Information Signs

Emergency signs direct workers to fire exits, first aid stations, emergency assembly points, and firefighting equipment. These signs use green or red backgrounds with clear white pictograms. In a large construction site, these should be posted at regular intervals and updated whenever the site layout changes. Ensuring these signs are never blocked by materials or machinery is a basic but critical requirement.

For a deeper look at how signage standards interact with broader traffic controls, visit our resource on road signage solutions provided by Revive Middle East.

Key Placement Rules for Construction Site Safety Signage

Even the highest quality construction site safety signage fails to protect workers if it is placed incorrectly. Placement is governed by both visibility principles and site-specific logic. Every sign must be readable from the intended viewing distance, free of obstructions, and mounted at an appropriate height.

  • Signs at entry and exit points should be mounted between 1.5 and 2.0 meters above ground level.
  • Temporary road-facing signs must be positioned before the hazard, not adjacent to it, to allow adequate reaction time.
  • Signs in high-dust or outdoor environments should be made from materials that resist fading, such as reflective sheeting or powder-coated aluminum.
  • Night-visible signage is mandatory near road-adjacent construction zones. Retroreflective materials or illuminated signs are the standard solution.
  • Signs must be inspected at regular intervals and replaced immediately if damaged, faded, or partially obscured.

These placement principles align with the standards discussed in our blog on key factors to consider when installing traffic signs, which provides additional technical guidance on sign installation.

Road Safety Equipment That Works Alongside Site Signage

Signage alone does not create a safe construction zone. It must be supported by physical road safety equipment that reinforces the warnings and boundaries communicated by the signs. In the UAE, construction sites near public roads are required to use a combination of signage, barriers, and delineation devices.

Common road safety equipment used in tandem with signage includes water-filled barriers, traffic cones, delineator posts, crash cushions, and guard rails. Each of these products creates a physical buffer between active work zones and pedestrian or vehicle traffic. When paired with clear, well-maintained construction site safety signage, they form a layered safety system that significantly reduces accident risk.

Revive Middle East supplies a comprehensive range of road safety barriers for industrial and commercial facilities, designed to complement construction site signage programs across the UAE. These products are built to withstand the demands of active construction environments and harsh weather conditions.

Guard rails are another essential product category. Installed along the edges of excavated areas, elevated platforms, and vehicle access routes, they prevent falls and accidental vehicle incursions into pedestrian zones. For more information on comprehensive traffic management approaches, see our overview of road safety contractor services in the UAE.

Compliance Standards and Regulatory Requirements in the UAE

The UAE has a structured framework for occupational health and safety on construction sites. Federal Law No. 8 of 1980 on Labour Relations and the subsequent ministerial resolutions on construction safety establish the baseline requirements for signage, personal protective equipment, and hazard communication.

In addition, each Emirate may have its own supplementary guidelines. In Dubai, for example, the Dubai Municipality enforces construction site safety standards that include specific provisions for signage in public-facing work zones. Abu Dhabi’s Integrated Transport Centre and the Abu Dhabi Department of Municipalities and Transport have similar requirements for sites near major road corridors.

Contractors must also be aware of international standards that are referenced in UAE procurement requirements. ISO 7010 defines graphical symbols for safety signs and is commonly cited in UAE project specifications. Aligning your signage program with ISO 7010 ensures that signs are universally understood, which is particularly important on multi-national construction sites.

Understanding these compliance layers is essential for contractors who want to avoid penalties and maintain project momentum. Signage audits should be built into the project schedule as a recurring activity, not a one-time installation task.

Choosing the Right Road Safety Products for Your Construction Site

Selecting road safety products for a construction site involves balancing durability, compliance, and practicality. Products must be able to withstand the physical demands of the construction environment, including heavy vehicle movement, vibration, dust, and temperature extremes common in the UAE climate.

When evaluating signage materials, reflective aluminum sheeting offers the best combination of durability and visibility for outdoor use. For temporary signs, PVC or corflute boards are practical and cost-effective for short-duration projects. All sign materials should meet the retroreflectivity requirements specified in applicable UAE standards to ensure visibility at night and during low-light conditions.

Contractors should also consider modular signage systems that allow quick reconfiguration as the site evolves. A construction project that spans many months will see hazard zones shift regularly. Having a flexible road safety products inventory means you can respond to those changes promptly without gaps in safety communication.

Partnering with a specialist supplier like Revive Middle East ensures that your signage and safety equipment selections meet UAE regulatory standards and project-specific requirements. Our team provides guidance on product selection, quantities, and placement strategies tailored to your site layout.

Conclusion

Construction site safety signage is far more than a compliance checkbox. It is a frontline defense that protects workers, contractors, and the general public every day a project is active. From understanding the different sign categories to following correct placement rules, and integrating the right road safety equipment, every decision contributes to a safer site. UAE contractors who build a systematic approach to signage management will reduce accident risk, avoid regulatory penalties, and demonstrate a genuine commitment to safety. To explore how Revive Middle East can support your next project with quality road safety products and signage solutions, contact our team today.

Frequently Asked Questions

What are the most important types of construction site safety signage?

The most important types include mandatory signs, warning signs, prohibition signs, and emergency information signs. Each category communicates a specific instruction or hazard alert. Using all four types ensures workers and visitors receive complete safety guidance across every zone of an active construction site.

Is construction site safety signage legally required in the UAE?

Yes, UAE Federal Law and emirate-level regulations require contractors to display proper construction site safety signage at all entry points and hazard zones. Non-compliance can result in fines, project stoppages, and increased liability. Consulting a qualified road safety contractor in the UAE helps ensure full regulatory alignment.

How often should construction site signs be inspected and replaced?

Signs should be inspected at least once per week and after any significant weather event or site activity that could cause damage. Faded, torn, or obscured signs must be replaced immediately. Regular audits should be scheduled as a standard part of project safety management protocols throughout the construction lifecycle.

What materials are best for outdoor construction site safety signs in the UAE?

Reflective aluminum sheeting is the preferred material for permanent or long-duration signs in the UAE due to its durability and heat resistance. For short-term use, PVC or corflute boards are practical alternatives. All materials should meet UAE retroreflectivity standards for visibility during nighttime and low-light conditions.

What road safety equipment should be used alongside site signage?

Alongside signage, contractors should deploy water-filled barriers, traffic cones, delineator posts, guard rails, and crash cushions. These physical road safety equipment items create protective buffers between work zones and vehicle or pedestrian traffic. Combined with clear signage, they form a layered safety system that reduces accident risk significantly on active sites.

How should construction site signs be mounted and positioned?

Signs should be mounted between 1.5 and 2.0 meters above ground level at entry points. Road-facing signs must be positioned before the hazard to allow adequate reaction time. Reviewing key factors when installing traffic signs provides additional guidance on correct positioning and structural mounting requirements for various site conditions.

What international standards apply to construction site safety signage in the UAE?

ISO 7010 is the primary international standard referenced in UAE project specifications for safety sign graphics. It defines universally recognized symbols for warnings, mandatory actions, prohibitions, and emergency information. Aligning your signage program with ISO 7010 ensures compliance and clarity across multi-national workforces common on large UAE construction projects.

Can temporary construction signs be used for long-term projects?

Temporary signs are acceptable for short-duration hazards but are not suitable as permanent solutions for long-term projects. Extended exposure to UAE heat and dust degrades temporary sign materials quickly. For projects lasting several months, investing in durable aluminum or reflective sheeting signs ensures consistent visibility and compliance throughout the entire construction period.

How does road line marking contribute to construction site safety?

Road line marking defines vehicle lanes, pedestrian walkways, exclusion zones, and turning paths within and around construction sites. Clear markings reduce confusion and prevent accidental vehicle incursions into restricted areas. Contractors working on sites adjacent to public roads should consult road line marking services to ensure demarcation meets traffic management standards.

What should a contractor do if site conditions change and existing signage no longer applies?

When site conditions change, contractors must update signage immediately to reflect new hazards, access routes, or exclusion zones. Outdated signs create confusion and can increase accident risk. A modular signage system allows quick reconfiguration. Regularly reviewing your safety equipment standards as a UAE contractor ensures your signage program stays current and compliant.

How Traffic Safety Equipment Helps Reduce Accidents and Improve Road Safety

Traffic safety equipment plays a vital role in protecting lives on roads across the UAE. From busy urban highways to construction zones, the right road safety infrastructure can significantly reduce collision risks and improve the flow of traffic. In this blog, we explore the key types of traffic safety equipment, how each one contributes to accident prevention, and why investing in quality road safety products is essential for municipalities, contractors, and infrastructure developers.

Key Takeaways

  • Traffic safety equipment includes traffic signs, guard rails, road markings, and road furniture that work together to prevent accidents.
  • Road safety equipment must meet regulatory standards to be effective in real-world traffic environments.
  • Quality road safety products reduce accident rates, improve driver awareness, and support structured traffic flow on UAE roads.

Why Traffic Safety Equipment Matters on UAE Roads

The UAE has one of the most rapidly growing road networks in the Middle East. With increasing vehicle density and large-scale infrastructure projects underway, the demand for reliable traffic safety equipment has never been higher. Road authorities, municipalities, and construction companies all depend on durable safety infrastructure to manage traffic effectively.

According to the World Health Organization, road traffic injuries are a leading cause of death globally, claiming approximately 1.19 million lives each year. Proper installation of road safety equipment is one of the most proven methods to reduce these numbers.

At Revive Middle East, we manufacture and supply a comprehensive range of traffic safety equipment tailored to UAE road standards. Explore our full range on the our products page to see how each solution supports safer roads.

Essential Types of Road Safety Equipment and Their Functions

Understanding what qualifies as road safety equipment helps planners and contractors make better procurement decisions. Each product category addresses a specific safety challenge on the road.

Traffic Signs and Their Role in Accident Prevention

Traffic signs are among the most fundamental forms of traffic safety equipment. They communicate critical information to drivers, including speed limits, road conditions, directions, and hazard warnings. A well-placed and clearly visible sign can prevent lane departures, wrong-way driving, and intersection collisions. In construction zones especially, traffic signs must be highly reflective and weather-resistant to maintain visibility in all conditions. Custom-fabricated signage that meets UAE road authority standards is essential for regulatory compliance and driver safety. Revive Middle East produces a wide range of traffic signs designed for high-visibility performance.

Guard Rails as a Critical Road Safety Product

Guard rails are one of the most impact-critical categories of road safety products. They are installed along highways, bridges, medians, and sharp curves to prevent vehicles from veering off the road or crossing into oncoming traffic. A properly installed guard rail absorbs crash energy and redirects vehicles back onto the travel lane, reducing the severity of accidents significantly. For infrastructure projects in the UAE, guard rails must be designed to withstand high-speed impacts and harsh desert weather conditions. Learn more about safety barrier solutions that protect both drivers and roadside workers.

Road Markings and Visibility Infrastructure

Road markings are a passive but powerful form of traffic safety equipment. Lane lines, pedestrian crossings, stop lines, and directional arrows all guide driver behavior without requiring active intervention. High-quality thermoplastic road markings offer superior durability and reflectivity compared to standard paint, making them ideal for UAE road conditions. Faded or missing road markings are a common contributing factor in lane-change accidents and pedestrian incidents. Revive Middle East specializes in thermoplastic road markings that maintain long-term visibility. For a deeper understanding of why marking standards matter, read our blog on why quality road markings are critical for traffic safety.

Road Furniture and Supporting Safety Infrastructure

Road furniture encompasses a broad category of road safety products including streetlamp poles, aluminum railings, road gantries, and delineators. These elements may seem secondary, but they play a critical role in structuring traffic environments and improving overall safety. Streetlamp poles ensure adequate night-time visibility on roads where lighting is limited. Road gantries support overhead signage and signals that guide drivers across complex interchanges. Aluminum railings provide pedestrian protection along walkways and elevated structures. Together, these road furniture elements form a complete road safety equipment system that complements active traffic management. Explore the full scope of our work on the our projects page.

How Traffic Safety Equipment Reduces Accident Rates

Each category of traffic safety equipment contributes to accident reduction in a distinct way. When deployed together as an integrated system, the impact is measurable and sustained.

  • Improved driver awareness: Traffic signs and road markings provide constant visual cues that reduce driver error.
  • Physical barriers: Guard rails and safety barriers prevent vehicles from entering dangerous zones.
  • Structured traffic flow: Road gantries and directional markings reduce confusion at complex intersections and interchanges.
  • Night-time safety: Reflective materials and streetlamp poles ensure road visibility after dark.
  • Construction zone protection: Temporary safety equipment protects both workers and drivers during active construction phases.

According to the Federal Highway Administration, roadway departure crashes account for nearly half of all traffic fatalities in the United States. Similar patterns are observed globally, underlining the critical importance of deploying proper road safety equipment on every road type.

Choosing the Right Road Safety Products for Your Project

Selecting the right road safety products depends on several factors including road type, traffic volume, project phase, and applicable UAE regulatory standards. Government authorities and infrastructure contractors should always work with manufacturers who understand local compliance requirements.

Key considerations include material durability, reflectivity ratings, installation quality, and after-service support. Revive Middle East provides end-to-end solutions from manufacturing to installation and ongoing maintenance. Our team works closely with road authorities and construction managers to specify the most appropriate traffic safety equipment for each project.

To understand how traffic management requirements are structured in the UAE, our blog on UAE traffic management standards and compliance provides a comprehensive overview of what contractors and authorities need to know.

The Role of Quality Manufacturing in Road Safety

Not all traffic safety equipment is manufactured to the same standard. In high-temperature, high-UV environments like the UAE, inferior materials degrade quickly, leading to faded signs, cracked road markings, and compromised guard rail integrity. These failures directly increase accident risk.

Quality manufacturing ensures that road safety products maintain their performance characteristics over their intended service life. This includes the use of UV-resistant coatings, corrosion-proof metals, and high-grade thermoplastic compounds. Revive Middle East uses materials specifically selected for UAE climate conditions, ensuring that every product performs reliably from day one through years of operational use.

Our service model includes post-installation inspection and maintenance support, which ensures that traffic safety equipment continues to function as intended throughout its lifecycle. You can learn more about our full range of offerings on the our services page.

Conclusion

Traffic safety equipment is not simply a regulatory requirement. It is a foundational investment in human safety, infrastructure integrity, and efficient road operation. From traffic signs and road markings to guard rails and road furniture, every component of a well-designed road safety system contributes to reducing accidents and protecting lives. Revive Middle East is committed to manufacturing and supplying high-quality road safety equipment that meets UAE standards and the demands of real-world traffic environments. Whether you are planning a highway upgrade, a construction zone layout, or a full road safety audit, our team is ready to support your project with the right road safety products and professional expertise. Contact our team today to discuss your next road safety project and find the right solution for your infrastructure needs.

Frequently Asked Questions

What is traffic safety equipment and why is it important?

Traffic safety equipment includes signs, guard rails, road markings, barriers, and road furniture designed to protect drivers, pedestrians, and workers. It reduces accident risk by improving visibility and structuring traffic flow. Proper installation of these products is critical for regulatory compliance on UAE roads.

What are the most common types of road safety products used in the UAE?

The most common road safety products in the UAE include reflective traffic signs, thermoplastic road markings, guard rails, safety barriers, streetlamp poles, and road gantries. Each product addresses a specific safety need on highways, urban roads, and active construction zones across the country.

How do guard rails reduce accident severity on highways?

Guard rails absorb the energy of a vehicle impact and redirect the vehicle back onto the travel lane. This prevents vehicles from crossing medians into oncoming traffic or leaving the road entirely. Quality guard rails are designed to perform reliably under high-speed impact conditions in all weather.

Why are road markings considered essential road safety equipment?

Road markings guide driver behavior passively without requiring active signals. Lane lines, pedestrian crossings, and directional arrows reduce confusion and lane-departure incidents. Thermoplastic markings offer superior durability and reflectivity, making them the preferred choice for road marking applications on UAE highways and urban streets.

How does traffic safety equipment help reduce accidents in construction zones?

In construction zones, temporary traffic signs, barriers, delineators, and lane markings redirect drivers safely around work areas. Proper traffic safety equipment placement ensures that both workers and drivers are protected. Correct setup reduces the risk of work-zone collisions, which are among the most preventable accident types.

What standards apply to road safety equipment in the UAE?

Road safety equipment in the UAE must comply with standards set by relevant road and transport authorities. These standards govern sign dimensions, reflectivity levels, guard rail specifications, and marking materials. Working with an experienced manufacturer helps ensure that all installed products meet current UAE regulatory requirements.

How long does traffic safety equipment typically last in UAE conditions?

Lifespan depends on material quality and environmental exposure. In the UAE climate, UV-resistant coatings, corrosion-proof metals, and durable thermoplastic compounds extend product life significantly. Regular inspection and maintenance are also essential for clients managing their traffic infrastructure throughout its full service life.

What is the difference between passive and active road safety equipment?

Passive road safety equipment, such as signs, markings, and guard rails, works continuously without requiring activation. Active equipment includes traffic signals and dynamic message signs that change based on conditions. Both categories are essential for a comprehensive road safety system on modern UAE roads.

Who typically procures road safety products in the UAE?

Road safety products in the UAE are typically procured by government authorities, municipalities, road and transport departments, and infrastructure contractors. Real estate developers and industrial project managers also source road safety equipment for private road networks and facility access roads that require structured traffic management.

Can road safety equipment be customized for specific project requirements?

Yes, road safety equipment can be customized to meet project-specific requirements including sign dimensions, color coding, language, and material specifications. Revive Middle East manufactures custom traffic signage and road safety solutions tailored to UAE road authority standards, as demonstrated across our client portfolio of delivered road safety projects.
