Airport, Port and Logistics Yard Line Marking Specifications

Airport and port line marking is where ordinary road practice stops being useful. The loads are heavier, the tolerances are tighter, the colours mean different things, and the operator usually has its own standard that overrides anything a road specification says. Copying a highway item description onto an apron or a container yard drawing is the most common and most expensive mistake in this sector. This guide sets out what changes, and what a specification for these environments actually has to address.

Key Takeaways

  • Loads from reach stackers and aircraft are far outside anything a carriageway specification contemplates, so material selection starts again from first principles.
  • Setting out is a survey exercise, not a chalk line exercise. A small repeated error across a slot grid becomes an operational problem.
  • The operator’s own standard governs. Aviation and terminal marking conventions differ from road conventions in colour, dimension and meaning.

Why These Environments Are Different

An airport apron carries aircraft wheel loads concentrated on very small contact areas, plus the thermal and chemical exposure of jet exhaust and spilled fuel. A container terminal carries reach stackers and straddle carriers whose point loads exceed anything on a public road by a wide margin. A logistics yard sits between the two, with continuous heavy turning traffic on a surface that is often concrete rather than asphalt.

The consequence is that durability is decided by resistance to point loading and to chemical attack rather than by resistance to ordinary tyre abrasion. A material that performs well on a highway can be torn out of a container yard within weeks by a single turning movement under load, and no increase in film thickness will fix that.

Colour conventions change too. Aviation marking uses colours with defined operational meanings that do not map onto road practice, and terminal operators frequently run their own colour system for slot rows, hazardous goods areas and equipment lanes. Applying road colour logic in these environments produces markings that are technically neat and operationally meaningless.

Finally, the approval route is different. There is no municipal traffic authority to satisfy; instead the airport operator, the port authority or the facility’s own engineering department sets the standard and inspects the work. Their requirements should be obtained in writing before anything is priced.

Infographic comparing airport and port line marking demands against public road marking requirements

What these environments demand that a road specification does not

Apron and Airside Marking

Airside marking follows aviation convention closely, and the dimensions, colours and tolerances come from the operator’s manual rather than from road practice. Stand centre lines, lead in and lead out lines, stop bars, equipment restraint areas and service road crossings all have defined geometry, and small deviations matter because pilots and ground crews follow them precisely.

Material has to tolerate jet blast, fuel and hydraulic fluid, and repeated thermal cycling. It also has to be removable without damaging a pavement that is expensive to repair, because stand layouts change as aircraft types change. That combination usually pushes the specification toward products designed for the purpose rather than toward standard road thermoplastic.

Skid resistance is critical on a surface where aircraft and ground vehicles brake and turn, and large painted areas can reduce it. Anti skid aggregate is normally required rather than optional, and its specification should be stated explicitly.

Access is the hardest practical constraint. Airside work happens in short windows, under escort, with security clearance for every operative and every vehicle, and with an absolute requirement to leave the area clean of loose material. Foreign object debris control is not a housekeeping preference here, it is a condition of working at all. Where taxiway areas are involved, the window may be measured in hours across several nights.

Container Terminals and Slot Grids

A container port is marked as a grid of slot positions rather than as lanes, and the marking is the operational reference that the terminal system depends on. Slot lines, row identifiers, transfer lanes and equipment routes together tell drivers and automated systems where a box belongs, and an error in the grid propagates through every stack built on it.

This makes setting out a survey exercise. Control points are established, the grid is set out from them instrumentally, and the positions are checked before any material is applied. A five centimetre error repeated across forty rows is not a cosmetic problem, it is a stack that no longer aligns with the equipment envelope.

Material selection is dominated by the point loads from handling equipment and by the constant sweeping these facilities receive. Mechanical sweepers with rotating brushes will lift a poorly bonded marking quickly, so bond strength on a concrete substrate matters more here than almost anywhere else. Preparation follows the same logic set out for interior slabs in the guide to warehouse and factory floor marking, applied at a much larger scale.

Numerals and identifiers deserve their own attention. They are read from a cab at height and at an angle, which affects the type size and the proportions required, and they wear differently from lines because they sit within the driving path rather than along its edge.

Infographic showing survey control and tolerance requirements for airport and port line marking grids

Where tolerance is tight, and what happens when it slips

Logistics Yards and Distribution Hubs

External yards at distribution centres and free zone facilities are the most common version of this work in the UAE, and they sit between road and terminal practice. They carry heavy goods vehicles manoeuvring at low speed, trailer parking, dock approach lanes, pedestrian routes between the yard and the building, and usually a fuel or wash bay somewhere in the layout.

Trailer parking is where layouts most often fail. A bay drawn for the tractor and trailer length but without enough manoeuvring depth in front of it produces a yard that works on paper and jams in practice. As with car parks, the vehicle that sets the dimension is the largest that will realistically use the site, not the average.

Pedestrian separation matters more in a yard than almost anywhere else, because the vehicles are large, the driver’s blind spots are considerable and the pedestrians are often drivers walking to a site office. A marked and, where possible, physically protected route from the parking area to the building is a basic requirement rather than an enhancement.

Surface condition tends to be poorer in yards than elsewhere, because they are built to a lower specification than a road and then loaded harder. Assessing the substrate honestly before pricing an airport and port line marking package, or a yard package, avoids the familiar situation where the marking is blamed for a surface that was never sound.

Specifying and Procuring This Work

Start by obtaining the operator’s standard in writing. Airports, ports and large logistics operators almost always have one, and it will govern colours, dimensions, materials and inspection. A bill of quantities drafted without it will need to be reissued once the operator reviews the submission.

State the survey requirement explicitly. If the specification does not say that the layout will be set out from established control and checked instrumentally, some bidders will price a chalk line and a tape, and the price difference will look like efficiency until the grid is checked.

Define the material by performance rather than by name. Resistance to point loading, to fuel and hydraulic fluid, and to mechanical sweeping are the properties that matter, and specifying them lets a bidder propose the right product rather than the one they happen to stock. The general item structure in the guide to writing a road marking and signage BOQ transfers well to this sector.

Finally, price the access honestly. Escorted working, security clearance, short windows and strict cleanliness requirements all reduce productivity substantially, and a rate that ignores them will be revisited as a claim. Being explicit at tender produces rates that hold to completion.

Conclusion

Airport and port line marking is a specialist discipline that borrows very little from public road practice. Obtain the operator standard, treat setting out as survey work, specify the material by the loads and chemicals it must resist, and price the access realistically. Revive Middle East Paints manufactures its own marking material in Sharjah and works across yards, terminals and industrial facilities in the UAE. Contact our team to discuss a site.

2027 Smart Roads: Why Road Marking Materials Are Becoming Part of the Traffic-Tech Stack

Dubai has set a public target that 25% of all trips in the emirate will be smart and driverless by 2030. That goal quietly changes the brief for every road marking paint supplier UAE authorities and contractors work with, because the line on the road is now read by cameras as well as by drivers. Lane keeping systems, driver assistance features and future autonomous shuttles all depend on markings they can detect in glare, dust and darkness. If a 2027 tender is on your desk, speak with our Sharjah team about specifying materials that serve both audiences. This guide explains the evidence, the numbers and the procurement questions that matter.

Key Takeaways

  • Road markings are becoming part of the traffic technology stack. Cameras and LiDAR use them to hold a vehicle in its lane, so retroreflectivity and contrast now matter to machines as much as to people.
  • Dubai is already investing in marking renewal at scale, and its driverless transport target makes machine readable lines a practical requirement rather than a distant idea.
  • Buyers choosing a road marking paint supplier UAE projects can trust should ask for measurable performance, factory traceability and a maintenance method, not just a unit price.

From Paint to Data Layer: Why Machines Now Read Road Lines

A road line used to have one job: guide a human driver. Today it also feeds the sensors in modern vehicles. That shift turns marking material into a piece of safety infrastructure that software depends on.

Research is now measuring this directly. A 2025 study in the Journal of Traffic and Transportation Engineering tested motorway markings with cameras and LiDAR in different lighting and weather conditions. It found that retroreflectivity was a consistent predictor of machine detectability in camera images at night, and for LiDAR contrast in dry and moist conditions. Daytime visibility readings, however, did not reliably predict how well machines detected markings in daylight.

Regulators are moving in the same direction. In the United States, the federal rule on minimum pavement marking retroreflectivity requires agencies to use a method that keeps longitudinal markings at or above 50 mcd/m²/lx on roads with speed limits of 35 mph or more. It recommends 100 mcd/m²/lx on roads of 70 mph and above. The rule also notes that better markings will improve the ability of infrastructure to work with driver assistance and automated driving systems.

The lesson for the Gulf is simple. A marking that looks acceptable to an inspector at noon may still be hard for a camera to read at night. Specifications written for 2027 projects should treat night performance and edge definition as core requirements, not optional extras.

This also changes who cares about the line. Fleet operators, mobility start ups and vehicle manufacturers testing in the region all have a stake in consistent markings. A road authority that once answered only to motorists now answers to software teams as well, and that raises the bar for every supplier in the chain.

What the UAE and Global Numbers Say

The strongest signal for demand comes from the authorities themselves. Local investment, global safety targets and driverless transport plans all point toward more marking work and higher expectations for it.

In May 2025, Dubai’s Roads and Transport Authority announced that ground markings renewal had begun across 89 locations. The programme covers 50 major roads and 39 residential areas, with more than 30,000 linear metres of markings repainted under the 2025 Preventive Maintenance Plan. RTA said it uses top grade materials to help extend operational lifespan. The same authority estimates that the benefits of self driving transport in Dubai could be worth more than AED 22 billion per year.

The global picture explains why this matters. According to the World Health Organization, the global rate of road traffic deaths fell by 21% between 2011 and 2025, yet road crashes still claimed 1.16 million lives in 2025. The UN target is to halve road deaths and serious injuries by 2030 compared with 2021 levels. Clear, durable markings remain one of the most basic tools for reaching it.

Infographic for thermoplastic road marking contractor Dubai 2027 planning, showing RTA marking renewal figures, the Dubai driverless trip target, the US retroreflectivity minimum and WHO road death statistics

Key figures shaping road marking specifications for 2027

Taken together, these figures describe a market where volume and expectations are rising at the same time. More kilometres of line will be laid and renewed, and each one will be judged against a stricter idea of what good looks like.

Material Choices That Keep Markings Machine Readable

Not every marking system performs equally once sensors enter the picture. The material, the beads and the application method together decide whether a line stays readable through years of heat, sand and heavy traffic.

Thermoplastic remains the workhorse for UAE highways because it is laid thick, bonds well and resists wear. Any thermoplastic road marking contractor Dubai 2027 tenders are likely to shortlist will need to show how its material holds retroreflectivity over time, not just on handover day. Our comparison of thermoplastic, cold paint and MMA sets out where each system fits.

Glass beads do most of the work at night. Their size, grade and embedment depth decide how much light returns to a headlamp or a camera, which is why the role of glass beads in retroreflectivity deserves attention in every specification.

Climate is the other variable. Intense sun, high surface temperatures and abrasive sand reduce contrast faster here than in cooler regions. Understanding why road markings fade early in the UAE climate helps buyers set realistic inspection cycles. Clean, sharp edges also matter, because the 2025 study treated edge detectability as one of its core machine detectability measures.

Application quality closes the loop. A premium material laid at the wrong temperature, or on a dusty surface, will lose beads and edge definition early. Crews, equipment and surface preparation deserve the same scrutiny as the product data sheet.

What 2027 Tenders Are Likely to Ask a Supplier

Looking ahead, procurement teams are likely to write smarter specifications. The outlook points toward measurable performance, documented maintenance and fewer suppliers covering more of the road environment.

First, expect a request for a maintenance method. The US rule already requires agencies to adopt one, and Gulf authorities with driverless ambitions have good reason to follow a similar logic. Suppliers should be ready to support retroreflectivity measurement at handover and at agreed intervals.

Second, expect questions about origin and consistency. A locally manufactured product with batch records is easier to audit than an imported one with a long supply chain. Seeing how thermoplastic marking paint is manufactured shows what quality control looks like in practice.

Third, expect whole life thinking. A cheaper material that needs relining sooner often costs more over a contract term, and our breakdown of road marking cost per square metre explains the variables.

Finally, many buyers will prefer a single traffic management products supplier Middle East projects can rely on for markings, signs and barriers together. That keeps colour, reflectivity and installation standards consistent across a corridor. Revive Middle East supplies thermoplastic paints and road markings alongside traffic signs, bollards, guard rails and fencing from its base in Sharjah.

For contractors, the practical step is to prepare now. Keep product data sheets, bead specifications and batch records ready, and agree an inspection schedule with the client before work starts. Suppliers who can show that evidence quickly will be easier to approve when 2027 tender documents ask for it.

Conclusion

Smart roads do not start with software. They start with lines that a driver and a camera can both read, day and night, through a hot and dusty summer. The evidence from recent research, the scale of Dubai’s renewal work and the global push to cut road deaths all point to higher standards for marking materials. Choosing the right road marking paint supplier UAE projects depend on is now a technology decision as much as a paint decision. Revive Middle East manufactures thermoplastic road marking paint in Sharjah and supports contractors and authorities across the region. Share your project drawings with us to discuss specifications for your next tender.

Pedestrian Crossing Markings and School Zone Layouts

Pedestrian crossing markings are the only road markings whose success is measured in behaviour rather than appearance. A crossing that looks immaculate but is approached at speed has failed, and one that is worn but sits inside a well designed approach may still be working. The difference lies in the arrangement rather than in any single element. This guide sets out how pedestrian crossing markings and school zone layouts are put together within a wider road line marking scheme in the UAE, which treatments genuinely change driver behaviour, and why these markings wear faster than anything else on the road.

Key Takeaways

  • A crossing is an arrangement, not a marking. The approach treatment does more to reduce speed than the crossing itself.
  • Crossings sit exactly where vehicles brake, so they need a heavier specification than the straight sections either side of them.
  • Marking and signage must be designed together. A crossing without its advance warning sign gives the driver two different messages.

Crossing Types and What Each One Does

The most familiar of all pedestrian crossing markings, the zebra crossing, uses broad alternating bars laid along the direction of travel, and its strength is recognisability. Drivers identify it at a distance and from a shallow angle, which is exactly what is needed on an approach. Its weakness is that it grants priority without controlling speed, so it works well where approach speeds are already low and poorly where they are not.

Signal controlled crossings replace judgement with instruction and are the right answer on higher speed or higher volume roads. Their marking set is different: stop lines, studs or tactile surfaces at the kerb, and often a distinct surface treatment within the crossing area itself. The markings still matter, because the crossing has to be legible when the signal is not showing.

Raised crossings and speed tables combine the marking with a change in level, and they are the most reliable way of reducing approach speed. The marking on a raised crossing does two jobs at once: it identifies the crossing and it makes the change in level visible, which is why the ramp faces are usually marked separately from the crossing itself.

Refuge islands change the crossing from one long exposure into two short ones and are particularly valuable on wide UAE carriageways. They bring their own marking requirements, including approach nose markings and hatching, and the pedestrian crossing arrangement should be drawn as a whole rather than assembled from parts.

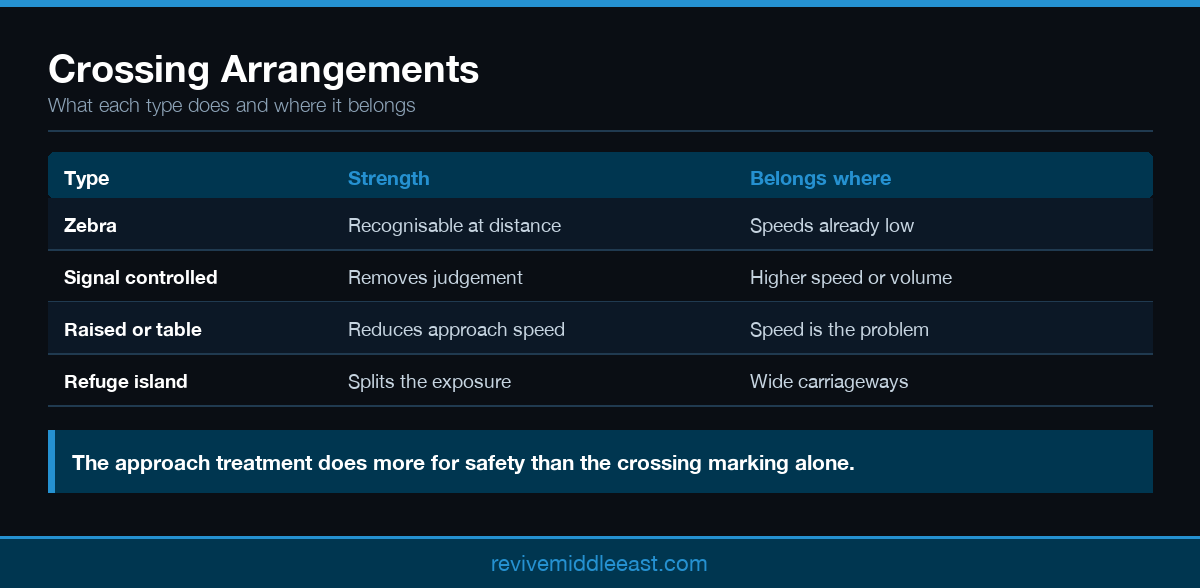

Infographic comparing zebra, signalised, raised and refuge island pedestrian crossing markings and their uses

Four crossing arrangements and where each belongs

The Approach Is Where Speed Is Actually Reduced

Most of the safety benefit at a crossing comes from the fifty to one hundred metres before it. Transverse bar markings at reducing spacing create an impression of accelerating speed and prompt drivers to lift off. Visual narrowing, achieved by bringing edge lines inward or adding hatching at the kerb, produces the same effect without physical works. Neither treatment is expensive and both outperform simply making the crossing brighter.

Advance warning markings and legends give the driver time to plan, and they follow the same conventions as the rest of the highway marking vocabulary. A legend on the carriageway is read earlier than a sign at the verge on a wide road, because the driver is already looking at the road surface. Combining the two is better than either alone, and the two should be positioned together rather than independently.

Sight lines matter as much as markings. A crossing placed where parked vehicles, planting or a bus shelter obscure a waiting pedestrian will not work regardless of how it is marked, and the correct response is to control parking on the approach with kerb markings rather than to add more paint to the crossing.

Consistency across a corridor is the quiet factor. If three crossings on the same road use three different approach treatments, drivers stop building an expectation, and expectation is what produces the automatic speed reduction these layouts are trying to create.

School Zones as a Complete Layout

A school zone is a corridor treatment rather than a point treatment. It usually begins with an entry marking and legend, continues with speed reduction elements and parking restrictions along the frontage, and ends with an exit marking that returns the road to its normal regime. Marking only the crossing outside the gate leaves the highest risk period, the arrival and departure surge, largely unaddressed.

Parking and stopping control is usually the most valuable element and the most contested. Kerb markings that prohibit stopping across the crossing approach and the school entrance keep sight lines open, which matters more than any other single measure. They need to be enforceable, which means they must be unambiguous and continuous rather than intermittent.

Set down and pick up areas deserve deliberate marking. Where parents have a clearly marked place to stop, they use it. Where they do not, they stop wherever is convenient, which is invariably on the crossing approach. Marking a defined bay area with a clear entry and exit is a cheap intervention with a large effect.

Pedestrian routes on the footway side should be marked or guarded where the desire line crosses a vehicle route, such as a car park entrance. This is the point where pedestrian guardrail and marking work together, channelling children to the controlled crossing point instead of the shortest route.

Infographic showing school zone layout elements including entry markings, parking restrictions and pedestrian crossing markings

The elements of a working school zone corridor

Materials, Wear and Maintenance Priority

Crossings take braking loads on almost every vehicle that passes, which is the harshest wear regime on any road. A crossing laid in the same material and thickness as the adjacent lane lines will fade several times faster, and the road will look neglected while the straight sections are still sound. Specifying a heavier material at the crossing itself is the correct response and costs very little across a whole scheme.

Skid resistance is a genuine concern because these markings are large, continuous and sit exactly where people walk and where vehicles brake. Anti skid aggregate applied with the drop on beads restores surface texture, and it should appear in the item description for any crossing with substantial painted area.

Colour contrast against the road surface does more for daytime conspicuity than material brightness, and pedestrian crossing markings depend on it heavily. On a light coloured aged asphalt surface, white markings lose contrast, and some authorities respond with a coloured surface treatment within or before the crossing. Where that is used, its maintenance regime has to be planned too, because a patchy coloured surface is worse than none.

Maintenance priority should be explicit. In any marking maintenance programme, pedestrian crossing markings and school zone elements belong at the top of the list, ahead of lane lines on a straight section that carries no conflict. That ordering is a policy decision and should be written down rather than left to whoever schedules the work.

Approvals, Coordination and Handover

Crossings on public roads require authority approval, and the submission usually covers the marking layout, the associated signage and any change to the road geometry as one package. Where the crossing serves a development, the car park layout behind it should be reviewed at the same time, because the two determine each other. Submitting the marking alone and dealing with signage later is a common cause of delay, because the reviewer will assess the arrangement as a whole.

School zone works carry a scheduling constraint that other marking does not. The work has to happen outside term time or outside school hours, and the window is fixed by the academic calendar rather than negotiable. Planning backwards from that window, including approval lead times, is the only reliable way to deliver it.

Coordination with the school or the facility operator is worth the effort. Gate positions change, temporary entrances open during building works, and a layout drawn from a two year old survey may address a gate nobody uses any more. A short walk of the site during arrival time answers more questions than a drawing review.

Handover should include the layout as built, the material and thickness records, and a note of the maintenance priority agreed for the site. Crossings are among the first markings to need attention, and the facility that knows this in advance plans for it instead of reacting to a complaint.

Conclusion

Pedestrian crossing markings work when the whole approach is designed to slow traffic, when the material matches the braking loads they take, and when marking and signage say the same thing. School zones need the same thinking applied along a corridor rather than at a single point. Revive Middle East Paints manufactures its own thermoplastic and installs crossing and school zone layouts across the UAE. Contact us to discuss a site.

Highway Line Marking Explained: Lane, Edge and Chevron Types

Every mark on a carriageway is an instruction, and drivers obey them without consciously reading them. Highway line marking works because the vocabulary is consistent: a broken line means one thing everywhere, a continuous line means another, and a hatched area means keep out. This guide takes the elements one at a time, explains what each is telling the driver, and sets out what the specification has to say for the finished line to do its job at night and in its third year rather than only on the day it is laid.

Key Takeaways

  • Longitudinal lines carry the lane discipline. Their width, cycle length and colour are what separate guidance from prohibition.
  • Hatching and chevrons are not decoration. They allocate space at merges and divergences and reduce the severity of a lane change gone wrong.
  • Night performance comes from beads and film thickness, not from the whiteness of the material, so both belong in the specification.

Longitudinal Lines: Lane, Centre and Edge

Longitudinal markings run with the direction of travel and do most of the work in any road line marking scheme. A broken lane line separates traffic moving the same way and permits a lane change. A continuous line prohibits it. A double line, or a combination of continuous and broken, sets different permissions for each direction. The cycle length of a broken line matters more than drivers realise, because the ratio of mark to gap communicates urgency: a shorter mark with a longer gap reads as ordinary lane discipline, while a short cycle warns of an approaching hazard.

Edge lines define the usable carriageway and are the element that carries most of the value at night and in poor visibility. On an unlit desert highway an edge line is often the only cue a driver has to the road’s alignment, which is why edge line retroreflectivity is usually specified more tightly than anything else on the road.

Line width is a specification decision rather than a default. Wider lines are more visible at speed and hold more beads, but they consume proportionally more material and cost more per kilometre. The practical answer is to widen where speed and geometry demand it and to keep the standard width elsewhere.

Colour follows convention and should never be improvised. White carries the ordinary lane and edge functions; yellow is reserved for the meanings the local authority assigns to it, commonly restriction or temporary works. Introducing a colour that the local convention does not use creates hesitation exactly where highway line marking is meant to remove it.

Infographic comparing highway line marking types including broken lane lines, continuous lines and edge lines

What each longitudinal marking type instructs the driver to do

Transverse Markings and Junction Elements

Transverse markings run across the carriageway and generally require an action rather than describing a permission. Stop lines, give way lines, yield triangles and box junction hatching all sit in this family, and they share a common problem: they are laid exactly where vehicles brake, which is the most punishing loading any marking receives.

That loading has a direct specification consequence. A stop line laid in the same material and thickness as the straight lane line either side of it will wear out several times faster, and the road will look neglected long before the general marking needs attention. Upgrading the material at braking areas is not gold plating, it is matching the specification to the load.

Give way and yield markings need to be legible on approach rather than only from directly above, which affects their proportions. A triangle that reads correctly in plan can be almost invisible at a shallow approach angle, so the drawn dimensions matter and should not be adjusted on site to fit an awkward geometry.

Box junctions and keep clear areas do a job that signage alone cannot. They mark space that must remain available, and their effectiveness depends on the outline being unambiguous and the internal hatching being complete. A partially worn box junction is worse than none, because drivers will treat the space as available.

Chevrons, Hatching and Diverging Areas

Chevrons and hatched areas appear where traffic streams separate or converge, and they allocate space that no vehicle should occupy. Their real function is to give a driver who misjudges a merge somewhere to go, and to make the geometry of the junction legible at speed rather than only on a plan.

The distinction between the two matters. Hatching bordered by a broken line marks an area a driver may enter if it is safe to do so. Hatching bordered by a continuous line marks an area that must not be entered at all. Getting that border wrong changes the legal meaning of the marking while leaving its appearance almost unchanged, which makes it one of the more consequential drafting errors on a highway drawing.

Chevron angle and spacing are set by approach speed. At higher speeds the chevrons are longer and more widely spaced, because a driver reads the pattern rather than the individual elements. Compressing a high speed chevron layout to fit a shorter available length destroys the effect it was drawn to produce.

These areas are also large, which makes them expensive and makes surface texture relevant. A wide continuous painted area can become slippery when wet, so anti skid aggregate is commonly specified alongside the drop on beads, and it should be stated in the item description rather than assumed.

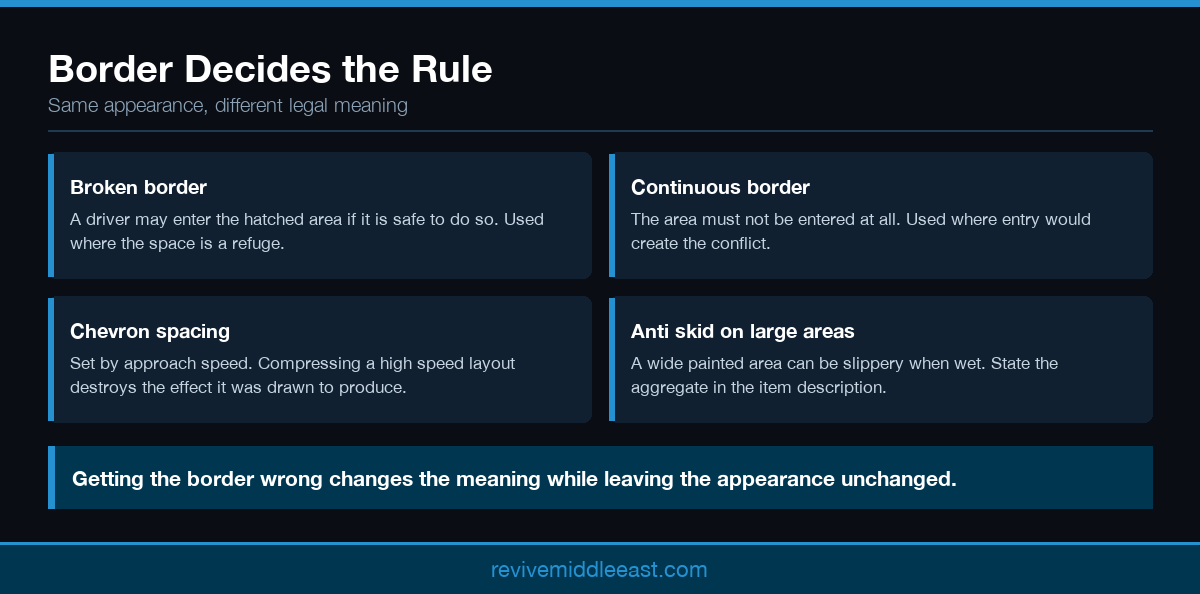

Infographic explaining hatching and chevron rules in highway line marking and what each border type means

Broken border or continuous border, and what changes

Rumble Strips and Tactile Treatments

A rumble strip works through sound and vibration rather than vision, which makes it the only marking that functions with the driver’s eyes elsewhere. Transverse rumble strips warn of an approaching hazard such as a junction or a speed change. Longitudinal ones warn that a vehicle is drifting out of lane or onto the shoulder, and on long unlit desert routes they address exactly the failure mode that causes the most serious collisions.

There are two ways to build them. Milled or cut rumble strips are formed in the pavement itself and last as long as the surface does. Raised or profiled thermoplastic strips are applied on top and can be laid without touching the pavement structure, which suits retrofitting an existing road. The applied version also carries beads, so it works visually as well as audibly.

Placement needs care. Rumble strips near residential frontage generate noise complaints, and the standard mitigation is to shorten the treated length or move it further from housing rather than to remove it. On the shoulder side, the strip must leave enough clear width for a cyclist or a broken down vehicle.

As a general rule, profiled treatments cost more per metre than flat marking and are worth it only where the specific failure they address is present. Applying them everywhere dilutes the warning and increases maintenance without a matching safety return.

Specifying Highway Marking Properly

A highway marking specification has to state four things before anything else: the material, the applied film thickness, the bead type and drop rate, and the required retroreflectivity at handover. Everything else is dimensional and comes from the drawing. Leaving any of the four open invites a bid that assumed the cheapest version, and the difference will not be visible on the day.

Thermoplastic is the usual answer on UAE carriageways because it combines depth with a set time short enough to reopen a lane quickly, and the reasoning is set out in the comparison of thermoplastic, cold paint and MMA. Where a section takes exceptional braking or turning loads, upgrading that area alone is more economical than upgrading the whole scheme.

Retroreflectivity should be stated as a value to be achieved and verified, not as an adjective. The measurement basis and the classes in BS EN 1436 give a common language for it, and the practical detail of how beads deliver that performance is covered in the guide to glass beads and retroreflectivity.

Finally, the specification should say when the work will happen. Most highway line marking in the UAE is laid at night behind an approved closure, and the sequence of that work affects both quality and cost. Planning it deliberately is covered in the guide to night works and lane closures, and the approval that permits it is covered in traffic diversion plan approval.

Conclusion

Highway line marking is a language, and the specification is what keeps it legible. State the material, the thickness, the beads and the retroreflectivity, draw the hatching borders correctly, and upgrade the braking areas rather than the whole road. Do that and the marking will still be doing its job at night in its third year. Revive Middle East Paints manufactures its own thermoplastic in Sharjah and marks highways across the Emirates. Speak to our team about your scheme.

Warehouse Floor Marking: Aisles, Walkways and Colour Coding

Warehouse floor marking is safety infrastructure that happens to be made of paint. It separates people from moving equipment, defines where loads may be placed, and tells a driver where a route ends before a collision does. Warehouse floor marking also takes more punishment than almost any road marking, because forklift wheels twist as well as roll. This guide covers the layout logic, the colour conventions worth adopting, and the preparation that decides whether the marking lasts five years or five months.

Key Takeaways

  • Separation of pedestrians from powered equipment is the primary purpose. Everything else in the layout is secondary to it.
  • A sealed or power floated slab will reject almost any material until it is mechanically abraded. Preparation is the whole job.
  • Colour must match the site safety scheme already in use, not a generic chart, or the floor and the signage will contradict each other.

Layout Logic: Separating People and Equipment

The first decision in any warehouse layout is where people walk and where machines drive, and the marking exists to make that decision visible and permanent. Pedestrian walkways should follow the natural desire lines between doors, welfare areas and workstations, because a walkway that requires a detour will simply be ignored. Where a walkway must cross a traffic route, the crossing point is marked deliberately and given priority rules that everyone on site understands.

Traffic routes are set out from the turning envelope of the equipment that uses them, not from the width of the aisle between racks. A counterbalance truck, a reach truck and a pallet truck all need different space, and the largest determines the route. Marking a route narrower than the equipment needs guarantees that the lines will be driven over and worn away within months, which is a reliable sign that the layout was wrong rather than the paint.

Storage and staging zones deserve their own treatment. Marked footprints for pallets, cages, empty equipment and waste keep floor space honest and make it obvious when an area is being used for something it was not designed for. These areas take direct impact from pallet corners, so the marking specification for them should be more robust than for a walkway.

Racking offsets and column protection lines complete the picture. A line set a defined distance from the racking leg gives drivers a visual cue and protects the structure, and it is far cheaper than replacing a damaged upright.

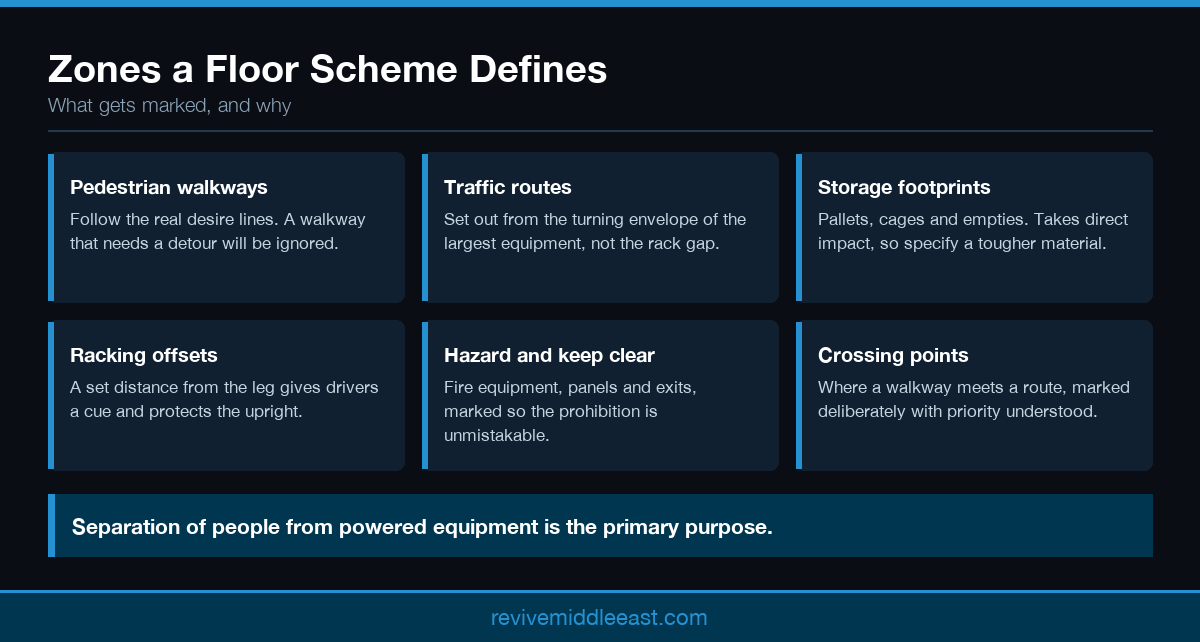

Infographic showing warehouse floor marking zones for walkways, forklift routes, storage footprints and hazard areas

The zones a warehouse floor marking scheme should define

Colour Coding That Actually Communicates

Colour carries meaning on a warehouse floor in a way it rarely does on a road, and the value comes entirely from consistency. A common working scheme uses one colour for pedestrian walkways, another for traffic routes, a third for storage footprints, and a strong contrast colour reserved for hazards and access that must never be blocked. The exact colours matter less than the discipline of using them the same way in every building the operator runs.

The scheme must be agreed with the operations and safety teams before any line is laid. Where the site already uses colour on its safety signage, the floor has to agree with it. A floor that calls a route yellow while the signage calls it green produces exactly the hesitation that marking is meant to remove.

Certain items should always be kept clear and are worth marking distinctly. Fire equipment, electrical panels, emergency exits and eye wash stations all need a keep clear footprint, and a hatched or striped treatment reads as a prohibition in a way a plain outline does not.

Resist the temptation to introduce more colours than the workforce can remember. Four or five meanings is the practical limit. Beyond that, the scheme stops being a language and becomes decoration, and staff revert to reading the floor as simply marked or unmarked.

Slab Preparation and Material Selection

The slab decides everything. Most modern UAE distribution centres have a power floated concrete floor, frequently with a surface hardener or a sealer, and both leave a dense closed surface that gives a marking material nothing to key into. Applied without preparation, the marking bonds to the treatment rather than to the concrete, and the first hard turn from a loaded truck lifts it.

Mechanical abrasion is the answer. Diamond grinding, shot blasting or aggressive sanding of the marking footprint opens the surface, and a primer matched to the substrate does the rest. This is the same principle set out for road work in the guide to surface preparation and primer selection, applied to a much harder and much smoother substrate.

Material selection for interiors follows different priorities from road work. Night visibility is irrelevant, so glass beads add little. Chemical resistance matters, because floors are cleaned with detergents and occasionally see hydraulic oil. Abrasion resistance under a twisting point load matters most of all. Two component resin systems and heavy duty thermoplastic both perform well, and the choice usually comes down to the available closure window.

Line width indoors is typically wider than on a road, commonly in the region of 75 to 100 millimetres for routes and wider still for hazard areas, because the marking is read at close range from a cab and because a wider line simply survives longer under point loading.

Infographic showing slab preparation steps that prevent warehouse floor marking adhesion failure

Why warehouse floor marking fails, and what prevents it

Working Around a Live Facility

Very few distribution centres can close. The realistic approach is zonal: isolate a section, prepare and mark it, protect it while it cures, and hand it back before moving on. This requires a material with a predictable set time and a physical exclusion arrangement rather than a verbal warning, because a forklift crossing a soft line destroys the line and spreads material across the floor.

Dust control during preparation is the constraint that surprises people. Grinding and blasting generate fine dust that will not be tolerated anywhere near food, pharmaceutical or electronics storage. Vacuum shrouded equipment and temporary screening are standard requirements, and they should be priced rather than assumed.

Programme fragmentation, not material, is what drives the cost of an industrial marking package. A facility that offers a single continuous weekend will be marked far more cheaply per square metre than one that offers four hours a night across three weeks. Being honest about the available access at tender stage produces rates that hold.

Where operations genuinely cannot pause, temporary marking in a removable material can hold a layout while a permanent scheme is planned. It is not a substitute for the real thing, but it beats an unmarked floor during a transition.

Inspection, Wear and Renewal

A warehouse floor marking scheme should be inspected on the same cycle as other safety infrastructure rather than when someone notices it looks tired. Walkway edges, crossing points and route intersections wear first because they take the most turning traffic, and a faded crossing point is a genuine risk rather than a cosmetic issue.

Impact damage is a separate failure mode from ordinary wear, and warehouse floor marking sees plenty of it. A pallet dropped on a storage footprint or a truck mast catching a line removes material in one event, and a repair patch is entirely acceptable provided the same material and colour are used. Mismatched patches are worse than the damage because they undermine confidence in the colour scheme.

Renewal is the right time to review the layout rather than reproduce it. Operations change, racking is reconfigured and volumes shift, and a marking scheme drawn for a previous use pattern will be quietly ignored by the people working there. If staff are routinely walking outside the walkway, the walkway is in the wrong place.

Keeping a marked up floor plan with the scheme, the colour meanings and the last renewal date turns the marking into a managed asset. It also makes the next contractor’s job straightforward, which usually shows up in the price.

Conclusion

Warehouse floor marking earns its cost by keeping people and equipment apart, and it only does that if it survives the traffic. Prepare the slab properly, choose a material for abrasion and chemical resistance rather than for road performance, agree the colour scheme with the people who work there, and plan the access honestly. Revive Middle East Paints marks industrial floors, yards and logistics facilities across the UAE. Contact our team to arrange a site survey.

Car Park Line Marking Layout: Bays and Aisle Widths

Car park line marking is judged by drivers within seconds and by inspectors within minutes, and both are unforgiving. A bay two hundred millimetres too narrow, an aisle that will not take a comfortable reverse, or an accessible bay without its transfer zone will all be noticed. The layout is where these outcomes are decided, long before any material is chosen. This guide covers the dimensions that matter in UAE developments, how they interact, and the mistakes that most often send a car park back for rework.

Key Takeaways

  • Bay width and aisle width are a pair. Narrowing one forces the other wider, and a layout that ignores that relationship will not work in practice.
  • Accessible bays need the bay, the hatched transfer zone and the symbol together. Two out of three is a failed inspection.
  • Set out from the structural grid and the drainage falls, not from an existing marking that may itself have been laid incorrectly.

Bay Dimensions and What Drives Them

A standard parking space in a UAE development is generally laid out at around 2.4 to 2.6 metres wide and 5.0 to 5.4 metres long, with the exact figures set by the authority having jurisdiction and by the building’s own design code. The range exists because bay width is a commercial decision as much as a technical one. Narrow bays yield more spaces per floor plate; wide bays yield fewer complaints and less door damage.

Width should respond to the user. A long stay office car park can work at the lower end of the range because drivers park once and leave. A retail or hospital car park with high turnover, families and trolleys needs the upper end, because doors open fully and repeatedly all day. Applying an office dimension to a retail site is the single most common cause of a car park that technically complies and practically fails.

End bays are a special case and are consistently under provided. A bay against a wall or a column loses usable width on one side, and unless it is widened by two hundred millimetres or more it becomes the space nobody chooses. Marking it at the standard width satisfies a drawing and creates a permanently empty bay.

Line width itself is worth stating in the specification. A 100 mm line reads cleanly and wears predictably. Thinner lines look neat on the day and disappear within a year in a busy facility, particularly where mechanical sweepers run daily.

Infographic showing car park line marking bay widths, lengths and aisle widths by parking angle

Working bay and aisle dimensions for UAE car parks

Aisle Width, Angle and Turning

Aisle width and parking angle are inseparable. Ninety degree bays give the most spaces and demand the widest aisle, typically six metres or more for comfortable two way circulation. Angled bays at sixty or forty five degrees need less aisle width but consume more area per space and generally require one way circulation, which changes the whole traffic plan for the floor.

The test that matters is the reverse out. A driver leaving a ninety degree bay needs enough aisle to swing the front of the vehicle clear without a second shunt, and the vehicle that sets the requirement is the largest one that will realistically use the site. In the UAE that is usually a large sport utility vehicle rather than a small hatchback, and designing to the small car is how a car park ends up permanently congested.

Circulation direction must be marked as clearly as the bays themselves. Directional arrows, give way markings at aisle intersections and a clear route to the exit do more for a car park’s usability than any amount of signage. Where the aisle also serves as a fire tender route, the required width may exceed the parking requirement, and that governs.

Column positions are the practical constraint that overrides theory. Structural grids rarely align neatly with an ideal bay module, and the honest approach is to set out from the grid, accept the loss where the grid forces it, and widen the bays that lose usable width to a column rather than pretending they are standard.

Accessible Bays and Hatching

Accessible parking is where car park line marking is most often non compliant, and it is also the most visible failure. An accessible bay is wider than a standard bay and is accompanied by a hatched transfer zone that gives a wheelchair user room to open a door fully and to move alongside the vehicle. The hatching is not decoration, it is the functional part of the arrangement.

Placement matters as much as dimension. Accessible bays belong on the shortest, flattest route to the lift lobby or entrance, and the route from the bay to that entrance must be free of kerbs without a dropped crossing. A correctly dimensioned bay at the far end of a sloping floor plate meets the drawing and fails the user.

The symbol should be laid to the correct proportions and orientated so it reads from the approach direction. It is normally applied in white on a blue field, and consistency across every floor matters because drivers scan for the colour rather than the shape. Where the site issues permits for accessible parking, the marking and the permit scheme should describe the same arrangement.

Two accessible bays sharing a single central transfer zone is an efficient arrangement and is widely accepted, provided the shared zone meets the full width requirement. It is a good way to recover space on a constrained floor plate without reducing the provision.

Infographic showing accessible bay dimensions, transfer zone hatching and symbol placement in car park line marking

The three elements of a compliant accessible bay arrangement

Setting Out, Materials and Sequencing

Setting out should begin from a fixed datum, normally the structural grid, and should be checked across the full floor before any material is laid. Working from an existing marking is tempting on a relining job and frequently repeats an error that has been there since handover. Half a day spent on setting out is cheaper than a floor of bays that are all fifty millimetres out of position.

Material choice in a car park is genuinely open, because traffic is slow and loads are light. Cold applied paint suits layouts that will change with tenants or with a future reconfiguration. Thermoplastic suits ramps, circulation roads and anything permanent, where braking and turning loads are real. The comparison of the three material families sets out where each belongs.

Substrate governs the preparation. Most multi storey car parks are concrete, often with a surface treatment or a waterproofing system, and both defeat adhesion until they are mechanically abraded. This is the most common reason car park markings peel within months, and it is entirely preventable. The guidance on surface preparation and primer selection applies directly.

Sequencing is the commercial risk. Marking sits near the end of a fit out programme, inherits every upstream delay and is then compressed. Booking the window early and protecting it produces better work than any premium on the rate, and phased handback of sections is always available where a full closure is impossible.

Inspection, Wear and Relining

A new car park should be inspected against the drawing rather than against appearance. Measure a sample of bays across each floor, check aisle widths at the tightest point, confirm accessible bay dimensions and hatching, and confirm that directional markings agree with the traffic plan. Recording those measurements at handover gives the facilities team a baseline that is otherwise impossible to reconstruct.

Wear is never uniform. Ramps, entry and exit lanes, and the aisles nearest the lift cores take several times the traffic of a remote corner, and they will need attention first. Planning car park line marking maintenance by zone rather than by floor keeps the busy areas presentable without repainting areas that are still fine.

Relining is the moment to correct an inherited layout rather than to reproduce it. If bays have always been slightly narrow or an aisle has always been tight, the relining is the only realistic opportunity to fix it, because the surface is already being prepared and the area is already closed.

Removal deserves a plan of its own where a layout is changing. Ghosting from an old line is visible under low light and confuses drivers, and the method used to remove the previous marking determines whether ghosting remains. Our guide to taking old lines off cleanly covers what each method leaves behind.

Conclusion

Good car park line marking is a dimensional exercise before it is a painting one. Get the bay and aisle relationship right, provide accessible bays properly, set out from the grid and prepare the substrate, and the result will still look correct in five years. Revive Middle East Paints marks car parks, ramps and circulation areas across the UAE using material manufactured in our own Sharjah plant. Send us your floor plans for a measured proposal.

Road Marking Cost per Square Metre in the UAE

Road marking cost is the line item most often misread in a UAE tender. Two bidders can quote the same square metre rate and deliver work that differs in film thickness, bead type and service life by a factor of three. The rate on the page is a summary of decisions made elsewhere, and if those decisions are not written into the scope, the cheapest bid is simply the one that assumed the least. This guide breaks road marking cost into the parts a rate actually contains, so a quotation can be compared against another on equal terms.

Key Takeaways

  • A square metre rate is meaningless without a stated film thickness, bead specification and a defined measurement rule for broken lines.
  • Material is rarely more than half of a marking rate. Traffic control, mobilisation and night working frequently cost more than the paint itself.
  • Removal, surface preparation and setting out are separate cost centres and belong in the bill as their own items.

What Sits Inside a Square Metre Rate

A road marking rate covers far more than material. A road surface marking item carries the delivered cost of the thermoplastic material or paint, the glass beads dropped onto it, the fuel and consumables burned by the kettle and applicator, the labour of a crew that typically runs four to six people, the transport of plant to site, and the supervision and quality records that follow the work. On a public road it also carries traffic control, and on many UAE schemes it carries the cost of working at night.

The proportions surprise people. On a straightforward highway relining contract with long uninterrupted runs, material can account for roughly half the rate. On a car park, a school frontage or a short urban stretch with heavy setting out and dozens of small symbols, material can fall below a quarter, because the crew spends most of its day measuring, masking and moving rather than laying.

This is why a single blended rate for a whole scheme hides more than it shows. A bill that prices longitudinal lines, transverse lines, symbols, hatching and legends separately will return bids that can actually be compared, because each contractor is pricing the same physical work.

The other half of the answer is that a rate is only as firm as the specification behind it. If the bill does not state applied thickness and bead type, the bidder is free to assume the thinnest and cheapest version that still looks correct on handover day.

Infographic breaking down road marking cost by material, labour, plant, traffic control and supervision

Where the money goes in a typical UAE road marking rate

Film Thickness Is the Biggest Single Cost Driver

Applied thickness decides how much material lands on each square metre, and material is bought by weight. A thermoplastic line laid at 3 mm consumes roughly half again as much material as the same line at 2 mm, and that difference flows straight into the rate. It is the easiest place for two quotations to diverge invisibly, because a 2 mm line and a 3 mm line look identical from a car on the day they are laid.

The difference shows up later. Thickness is what gives a marking its abrasion allowance and what keeps beads embedded as the surface wears. A line specified at 3 mm and delivered at 1.8 mm will hold its appearance for a season and then fade well inside the expected replacement cycle, which turns a saving on the first bill into a repeat cost on the second.

The remedy is simple and belongs in the bill rather than in the argument afterwards. State the applied thickness, state how it will be verified, and require thickness records by chainage. Wet film gauges during application and core or plate checks afterwards are both accepted practice, and neither adds meaningful cost when planned in advance. The performance classes in BS EN 1436 give a ready made language for stating what the finished line must achieve.

Bead specification behaves the same way. Drop on beads to a stated rate and refractive index cost real money per square metre, and a bidder who has assumed a lower drop rate will always look cheaper on paper. Understanding how glass beads and retroreflectivity work is what turns that from an invisible saving into a visible non compliance.

Traffic Control, Night Work and Access

On any live carriageway, the cost of protecting the crew and the traffic is a real and often dominant part of the price. Cones, signs, arrow boards, lead and tail vehicles, and the personnel to set and strike the layout all sit inside the marking rate unless the bill prices temporary traffic management separately, which on larger schemes it should.

Night working carries a further premium. Most UAE marking on trafficked roads happens after dark, partly for traffic reasons and partly because surface temperature during the day can put application outside the acceptable window. Night work brings lighting, shift allowances, reduced productivity and a shorter usable window between the last closure and the first commuter, and all of it lands in the rate. Planning the sequence of night works and lane closures well is one of the few levers that genuinely reduces this cost.

Access matters just as much on private sites. A warehouse yard that must be marked around live forklift traffic, or a car park that can only be closed in sections over three weekends, will price higher per square metre than the same area cleared for a single continuous shift. Contractors are pricing crew days, not just paint.

None of this is padding. A bidder who has left traffic control out of the rate has not found an efficiency, they have found an omission, and it reappears as a variation once the works start.

Infographic showing the conditions that raise or lower road marking cost per square metre in the UAE

The site conditions that move a marking rate up or down

Preparation and Removal Are Separate Costs

Two items regularly missing from a marking bill are surface preparation and removal of existing lines. Both are physical work, both consume plant and crew time, and both vary hugely by site. Pricing them inside the marking rate forces every bidder to guess, and the bid that guesses lowest wins for the wrong reason.

Preparation on new asphalt may be nothing more than sweeping. On an aged surface, on concrete, or where a previous marking has left residue, it can involve blasting, priming or both, and proper surface preparation is what decides whether the new line bonds at all. On a rehabilitation scheme it is not unusual for preparation to approach the cost of the marking itself.

Removal follows the same logic. Taking a thin cold paint line off asphalt is quick. Taking a full depth thermoplastic legend off a concrete apron without scarring the substrate is slow, and the method chosen changes both the price and the risk to the surface. The practical detail is covered in our guide to stripping old lines and re marking.

The cleanest approach is to bill preparation and removal as measured items with their own units, so the scheme pays for what it actually needs and every bid is arithmetic rather than assumption.

How to Compare Quotations Fairly

Start by normalising the measurement rule. A 100 mm broken line can be measured as painted area, as the full length of the run including gaps, or as linear metres, and the three give very different numbers for the same road. State the rule once in the preamble and every rate becomes comparable.

Next, fix the specification variables that move material consumption. Applied thickness, bead type and drop rate, colour, and whether the marking is standard or profiled all belong in the item description. Once those are locked, a lower road marking cost genuinely reflects better productivity or a shorter supply chain rather than a thinner line.

Then look at what stands behind the rate. A manufacturer that produces its own material carries a different cost structure from a trader buying imported product, and it also carries batch traceability, which matters when a section fails and the cause has to be established. Ask for batch certificates as a bid requirement, not a handover formality.

Finally, price the life rather than the day. A rate that is fifteen per cent lower but delivers two thirds of the service life is more expensive over any sensible horizon, and the traffic disruption of an early re mark rarely appears in the comparison at all. Whole of life thinking is the only way a road marking cost comparison reflects what the client will actually pay.

Anyone building a bill for the first time should set the item structure before the drawings are final, because retro fitting a measurement rule into a live contract is far harder than agreeing one at tender.

Conclusion

Road marking cost is not a single number, it is the output of a specification. Fix the thickness, the beads, the measurement rule and the traffic control arrangement, and the quotations that come back can be compared on equal terms. Leave them open and the lowest bid will simply be the one that assumed the least material and the shortest working window. Revive Middle East Paints manufactures its own thermoplastic and installs it across the UAE, which means the rate and the material behind it come from the same place. Request a priced proposal with your bill of quantities and drawings.

Screed, Spray or Extrusion: Road Marking Methods

Thermoplastic road marking application methods are usually treated as a contractor decision, but they belong in the specification. The method chosen sets the film thickness that can physically be delivered, and it changes the edge quality, the output rate and the cost. Specifying a thickness without naming a method leaves an ambiguity that will be resolved in the contractor favour. This article explains the three methods and where each one belongs.

Key Takeaways

  • Method and film thickness are linked. Spray cannot deliver a screed thickness, so specifying both together avoids disputes.
  • Screed suits wide markings and symbols. Extrusion gives the best edge on long runs. Spray covers area quickly at lower build.
  • Bead application timing matters more than the method itself for night time performance.

Why the Method Decides the Thickness

Each application method has a physical range of film thickness it can achieve, set by how the material is metered onto the road rather than by any choice on the day.

A screed box carries a reservoir of molten material and drags a shaped opening along the surface, so build is high by design. An extrusion unit pushes material through a die under pressure, which gives a similar build with sharper geometry. A spray unit atomises the material and lays it as a much thinner film, because that is the only way it can pass through the nozzle. Asking a spray unit to deliver a screed thickness is not a matter of turning up a dial.

This is why a specification that states a thickness but not a method creates an argument. Name both, and the requirement becomes enforceable.

Equipment scale is the other constraint the method brings with it. Screed and extrusion both require a heated kettle, transfer arrangements and a crew trained on that plant. Spray requires a different unit again. A contractor who owns only one type will tend to propose the method that suits their yard rather than the method that suits your specification, which is another reason to name it before tender.

Infographic comparing screed, extrusion and spray thermoplastic road marking application methods

The three application methods compared on the properties that affect specification

Screed Application

Screed application uses a heated box, either hand propelled or machine mounted, that is drawn along the marking line and lays material through a shaped aperture.

It delivers the highest build of the three methods, typically in the 2 to 3 mm range, which makes it the standard choice where longevity matters most. It handles wide markings comfortably and it is the practical method for symbols, arrows, letters and hatched areas where a template is used. Output per hour is lower than extrusion on long straight runs, and edge definition depends more on operator skill, but the depth of material it lays is hard to beat.

On most UAE schemes, screed is what goes down at junctions, on crossings, on stop bars and wherever a template is involved.

Template work deserves particular mention. Arrows, legends, cycle symbols and hatched areas are all laid through a template, and screed is the only method that handles them well at full film build. Where a scheme carries a lot of symbol work, the programme has to allow for it, because template marking is far slower per square metre than running a line.

Operator skill has more influence on screed work than on the other two methods. The box has to be drawn at a consistent speed to keep the film build even, and the finish at starts, stops and joins depends entirely on technique. On a scheme with a lot of screed work, the experience of the crew is a fair question to ask at tender stage.

Extrusion Application

Extrusion forces material through a shaped die under pressure, producing a line with very consistent geometry and a clean vertical edge.

Film thickness sits in a similar range to screed, so durability is comparable, but the finish is noticeably crisper and the output on long runs is higher. The die also allows profiled and ribbed markings to be formed, which raise sections of the line above the surrounding surface. Those profiles shed water better in rain, hold their retroreflectivity in wet conditions and can generate an audible warning when a vehicle crosses them.

For long carriageway runs, edge lines and lane lines on road line marking packages, extrusion is normally the most efficient choice.

Profiled markings are worth specifying deliberately rather than accepting as an option. Raised ribs formed by the die keep part of the line above a water film, which preserves night visibility in rain when a flat marking loses most of it. They also produce a rumble effect that alerts a driver drifting out of lane. The principle is the same one behind road surface markings generally, applied to wet weather performance.

Die condition is the equivalent variable for extrusion. A worn die produces a ragged edge and inconsistent build, and it deteriorates gradually enough that a crew can stop noticing. Asking when the dies were last replaced is a small question that says a good deal about how a contractor maintains its plant.

Spray Applied Thermoplastic

Spray application atomises molten material through a nozzle and lays it as a thin film across the surface, at a considerably lower build than the other two methods.

Its advantages are speed and coverage. Large areas can be marked quickly, the unit is lighter and more mobile, and material consumption per square metre is lower. The trade off is service life, since there is simply less material resisting abrasion and holding beads. Spray also copes better with slightly irregular surfaces, because it follows texture rather than bridging it.

It suits large area applications, refresh work over sound existing markings and situations where speed of installation outweighs longevity. It is not the right method for a marking expected to last for years under heavy traffic.

Spray also has a role that is often overlooked, which is marking large areas that are not lines at all. Coloured surfacing at bus boxes, hatched exclusion zones and wide area treatments are all impractical to screed and straightforward to spray. Judged on that work rather than on carriageway lines, its lower film build is a reasonable trade rather than a weakness.

Infographic showing which thermoplastic road marking application method suits each type of work

Selecting the application method by the type of marking being laid

Matching the Method to the Work

The choice comes down to three questions. How long must the marking last, what shape is it, and how much time is available inside the closure.

Long straight runs on a highway favour extrusion for output and edge quality. Symbols, arrows and wide transverse markings favour screed, because templates and depth both matter. Large area work and refresh passes favour spray, accepting the shorter life in exchange for speed. Many schemes use two methods on the same site, with extrusion running the lines and screed handling the detail work at junctions.

Whichever method is used, bead application timing is what decides night performance. Beads must land while the surface is still hot enough to accept them, as explained in our article on glass beads and retroreflectivity.

Finally, check that the method proposed matches the thickness the contractor has priced. A tender offering spray application against a screed thickness is either a misunderstanding or a deliberate ambiguity, and it is far easier to resolve at bid stage than after the first section is laid. The same logic applies across the whole thermoplastic specification.

Where a scheme is large enough to justify it, ask the contractor to lay a trial section using the proposed method and measure it before the main works begin. It settles thickness and finish questions cheaply, while there is still time to change the approach.

Naming the thermoplastic road marking application methods in the specification, alongside the required film thickness, removes the most common source of dispute at handover.

Conclusion

Thermoplastic road marking application methods are not interchangeable, and the choice belongs in the specification rather than on site. Screed delivers depth and handles templates. Extrusion delivers edge quality and output on long runs. Spray delivers speed at lower build. Name the method alongside the thickness and you remove the most common source of dispute at handover. Contact Revive Middle East Paints to discuss the right method for your works.

Inside a Thermoplastic Road Marking Paint Factory

Most specifiers never see where their road marking material comes from, and manufacturers of thermoplastic paints rarely open the doors. That is a shame, because almost every property you will later argue about on site is fixed inside the plant. Binder grade, pigment loading, bead content and batch consistency are all decided long before a kettle is lit. This article walks through what actually happens in production and what it means for the material arriving at your works.

Key Takeaways

  • Thermoplastic is manufactured as a dry blend. There is no solvent, so formulation controls performance almost entirely.
  • Batch records tie a delivered pallet back to specific raw materials and test results, which is the basis of any real warranty claim.
  • A trader can supply the same looking product without any ability to explain or repeat what is inside it.

What Actually Goes Into the Batch

A thermoplastic road marking material is a dry blend of four component groups, and the proportions between them decide almost everything about how the finished line behaves.

The binder is a hydrocarbon resin system, often modified with plasticiser and oil to control brittleness at low temperature and softening at high temperature. Filler, usually calcium carbonate or graded quartz sand, makes up the bulk and supplies abrasion resistance. Pigment provides colour, with titanium dioxide doing the work in white formulations and chrome free pigments in yellow. Glass beads are added as intermix so that the material can renew its own night performance as it wears.

For the Gulf market, binder grade is the decision that matters most. It is also the one most easily downgraded without any visible change to the product.

Yellow formulations follow the same structure with a different pigment package. The change sounds trivial and is not, because yellow pigments differ from titanium dioxide in opacity, in cost and in how they age under ultraviolet light. A yellow line will normally carry a lower retroreflectivity target than a white one for exactly this reason, and specifying the same value for both is a common specification error.

Raw Material Intake and Testing

Production quality starts at the gate. Every incoming raw material is sampled and checked against the specification the formulation depends on, and no batch is released into production before those checks pass.

Resin is checked for softening point and colour, because a resin that is off grade will shift the behaviour of the finished material at exactly the temperatures that matter here. Filler is checked for particle size distribution and moisture, since damp filler causes problems in the melt. Pigment is checked for whiteness and consistency, because low pigment loading produces a slightly grey line that will fail a luminance test. Glass beads are checked for roundness and gradation.

Each accepted delivery is logged against a lot number. That number is what later allows a finished pallet to be traced back to the exact materials that went into it.

Storage between intake and production is part of the quality chain and is easy to neglect. Filler and finished material both need to stay dry, because moisture trapped in the product causes foaming and poor flow the moment it reaches kettle temperature on site. A plant that tests raw materials carefully and then stores them badly has gained nothing.

Supplier qualification sits behind all of this. A plant that buys resin from whichever source is cheapest each quarter will produce material that varies from batch to batch, however carefully it tests. Stable supply relationships are unglamorous and they are a large part of why one manufacturer delivers consistent product and another does not.

Infographic showing the manufacturing sequence used by manufacturers of thermoplastic paints

From raw material intake to a traceable pallet leaving the plant

Hot Blending and Why Sequence Matters

Blending is done hot, in a heated mixer, and the order in which materials are introduced changes the result. This is process knowledge rather than recipe knowledge, and it is where experienced manufacturers separate themselves.

The binder is brought up to temperature first and held there so it flows properly. Filler is then introduced gradually under agitation so that the binder fully wets every particle. Adding filler too quickly leaves dry agglomerates that show up later as weak points in the applied line. Pigment follows, and it must be dispersed completely or the finished marking will show colour variation. Intermix beads go in last and at controlled temperature, because excessive heat or over mixing fractures them and a fractured bead does not retroreflect.

Mixing time and temperature are both recorded. Over processing degrades the binder just as surely as under processing leaves it poorly blended.

Temperature control during blending is the other constant. Holding the melt too hot for too long degrades the binder, which shows up later as a line that becomes brittle sooner than it should. Every batch therefore has a time and temperature envelope rather than simply a target, and staying inside it is a matter of process discipline rather than equipment.

This is where experienced manufacturers of thermoplastic paints separate themselves from operations that simply follow a recipe.

Batch Quality Control Before Release

A batch is not finished when the mixer stops. A sample is drawn and tested against the approved formulation before any of it is packed for despatch.

Softening point confirms that the binder system will hold its shape at road surface temperature rather than tracking under traffic. Whiteness or luminance is measured against the target so the material will pass a colour requirement on site. Bead content is verified, since it cannot be checked once the material is packed. Flow and workability are assessed to confirm the material will lay properly through screed or extrusion equipment at normal application temperature.

Results are recorded against the batch number and retained. If a question arises about material performance two years later, this record is the only thing that can answer it.

Retained samples matter as much as the test results. Keeping a physical sample from each batch means a question raised in eighteen months can be answered by testing the original material rather than by argument. It is inexpensive to do and it is one of the clearest signals that a supplier expects to stand behind what it produces.

Infographic showing the four batch quality control tests run before thermoplastic material is released

What a batch is tested for before it is allowed to leave the plant

What Traceability Gives You on Site

Traceability sounds like paperwork until something goes wrong, at which point it becomes the difference between a resolved problem and an unresolvable argument.

If a section of marking underperforms, a batch record lets you establish whether the material met specification when it left the plant. That single fact separates a material problem from an application problem, and the two have completely different remedies. It also lets a manufacturer reproduce the same formulation for a later phase of the same road, so that markings installed two years apart still match in colour and performance. A trader buying from whichever source is cheapest that quarter cannot offer either guarantee.

Revive Middle East Paints manufactures thermoplastic material at its plant in Emirates Industrial City, Sharjah, and installs it across the Emirates. You can see the projects we have delivered for context.

There is a second, less obvious benefit for a road authority. Consistent formulation across phases means the network ages predictably, which makes a planned remarking programme possible. When material varies from batch to batch, sections installed in the same month start failing at different times and maintenance becomes reactive. Our overview of traffic management services explains how that planning works in practice.

In short, ask three questions of any supplier. Where was this made, what is in it, and can you make it again next year to the same specification. A manufacturer answers all three from records. A trader can usually answer none of them.

Manufacturers of thermoplastic paints who retain batch records can answer a performance question years later, which a trading intermediary cannot.

Conclusion

Manufacturers of thermoplastic paints decide most of what happens on your road long before the material reaches site. Raw material control, blending discipline and honest batch testing are what make one white granular product behave differently from another that looks identical. When you are buying, ask where the material was made, ask for the batch record, and ask whether the supplier can reproduce the same formulation next year. Get in touch to discuss supply for your project.

Road Marking Removal Methods for UAE Contractors

Road marking removal in the UAE gets far less attention than application, and it causes far more lasting damage when it goes wrong. A badly removed line leaves a scar that drivers still read as a marking at night, which is a genuine safety problem rather than a cosmetic one. This article compares the three removal methods used here, explains the damage each one can do, and sets out how to choose without wrecking the surface underneath.

Key Takeaways

  • A ghost marking left after poor removal can still be read by drivers at night, especially in wet conditions.
  • Water jetting is the least damaging method on asphalt. Grinding is the fastest and the most destructive.
  • Removal method should be selected from the substrate and the marking material, not from whatever plant is already on site.

Why Removal Quality Matters More Than Speed

Removing a marking is not simply the reverse of laying one. The material has bonded into the surface texture, and taking it out always takes some of the road with it.

Two problems follow. The first is the ghost marking, a visible outline left where the removed line used to be. It appears because the road under the marking has been shielded from wear, weathering and dust for years, so it is a different colour and texture from its surroundings. At night, and especially in the wet, drivers can still read that outline as a live marking. The second is surface damage. Aggressive removal opens the asphalt, which then ravels, holds water and deteriorates faster than the surrounding surface.

On a live carriageway, both problems are safety issues rather than presentation issues, which is why removal deserves the same specification attention as application.

There is a commercial dimension as well. Damage caused during removal usually falls outside the marking contract and lands with whoever owns the road, which means it is discovered long after the crew has left. Specifying the removal method, and inspecting the surface immediately after removal rather than after reinstatement, keeps responsibility where it belongs.

High Pressure Water Jetting

Water jetting, sometimes called hydro blasting, uses water at very high pressure to break the marking material away from the surface without cutting into it.

It is the gentlest of the three methods on asphalt, because water follows the texture of the road rather than machining a flat plane across it. That makes it the preferred choice on a surface that has to stay in service. It removes thermoplastic and cold plastic effectively, it produces very little ghosting when done properly, and it generates no airborne dust. The trade offs are output rate, the need to manage water and paint residue as a waste stream, and a higher cost per square metre than grinding.

For most permanent works on trafficked UAE roads, water jetting is the method that leaves the road in the best condition.

Pressure and nozzle configuration both need controlling. Too little pressure leaves residue keyed into the texture, which then shows as a patchy ghost. Too much begins to cut into the asphalt matrix and undoes the main advantage of the method. This is operator dependent work, and experience with the particular surface type matters more than the rating of the machine.

Water management is the practical constraint on jetting in the UAE. The residue has to be collected rather than allowed to run into a drainage system, and on a long run that means either a vacuum recovery unit working alongside the jetting head or a containment arrangement that adds time to the operation. Pricing that in at tender avoids an awkward conversation on site.

For asphalt that has to stay in service, water jetting is the road marking removal method that leaves the surface in the best condition.

Infographic comparing water jetting, grinding and shot blasting for road marking removal in the UAE

The three removal methods compared on damage, output and cost

Grinding and Scarifying

Grinding uses rotating cutters or a scarifying head to mill the marking off the surface mechanically, taking a thin layer of the road with it.

It is by far the fastest and cheapest method, and on concrete or on a surface that is about to be resurfaced anyway it is entirely reasonable. On asphalt that has to remain in service it is the most damaging option available. It leaves a milled texture that is clearly visible as a scar, it opens the surface to water ingress and ravelling, and it is very unforgiving of operator error since a moment of excessive depth cannot be undone.

Grinding is best reserved for concrete surfaces, for temporary layouts and for sections programmed for resurfacing shortly afterwards.

Grinding also generates significant airborne dust unless the head is enclosed and extracted, which is a real consideration on live roads and in built up areas across the Emirates. Where the works sit near occupied buildings, that alone can rule the method out regardless of its cost advantage. Dust control obligations normally sit inside the wider traffic management and site safety arrangements for the works.

Shot Blasting

Shot blasting propels steel abrasive at the surface within an enclosed head and recovers both the shot and the debris as it works.

It sits between the other two methods on aggression and on cost. It removes thermoplastic well, it leaves a uniform texture rather than the directional scoring that grinding produces, and the enclosed head controls dust and allows the abrasive to be recycled. It is more aggressive than water jetting and will lightly texture the road surface, which on a sound asphalt is usually acceptable and on a fragile or thin surface is not.

It performs particularly well on concrete and on large open areas such as aprons and yards, where output matters and the substrate can take it.

Recovery of the abrasive is what makes shot blasting practical at scale. The head collects the shot along with the removed material, separates the two and returns the shot to the hopper, so consumption stays low across a large area. That closed loop also keeps the working area much cleaner than open blasting, which matters when the adjacent lane is carrying traffic.

Selecting a road marking removal method from the substrate rather than from the available plant is what prevents long term damage.

Infographic showing four risks to manage during road marking removal in the UAE

The four risks that turn a removal job into a long term road defect

Choosing a Method Without Scarring the Road

The choice should start with two facts. What is the marking made of, and what is it sitting on. Those two answers narrow the options quickly.

Thermoplastic and cold plastic on asphalt that must stay in service point firmly toward water jetting. Any material on concrete tolerates shot blasting or grinding comfortably. Thin cold applied paint often needs far less aggression than crews assume, and over specifying the method causes unnecessary damage. Where the section is due for resurfacing shortly, grinding becomes the sensible economic choice because the scar disappears under the new layer.

Whichever method is selected, plan the reinstatement at the same time. If a new marking is going back in the same place, the removal has effectively become surface preparation and should be treated to that standard. Our road line marking services cover removal and reapplication as a single sequence.

Whatever method is chosen, plan for the ghost. If a marking is being permanently removed rather than replaced, the shielded strip left behind will remain visible for a long time and drivers will read it, particularly at night and in the wet. Surface treatment over the removed line is sometimes the only honest answer, and it needs to be priced at tender rather than discovered afterwards. The principles behind road surface marking visibility apply just as much to a line you are trying to erase.

Removal is also the moment to check the surface beneath. Once the old marking is off, defects that were hidden under it become visible, and repairing them before the new line goes down is far cheaper than reopening the closure later.

Plan road marking removal and reinstatement as a single sequence inside the same closure wherever the programme allows it.

Conclusion

Road marking removal in the UAE deserves the same specification discipline as application, because the consequences of getting it wrong stay on the road for years. Water jetting protects asphalt that has to remain in service. Shot blasting suits concrete and open areas. Grinding is fast and cheap and belongs where the surface is about to be replaced. Choose from the substrate rather than from the plant on site. Contact Revive Middle East Paints to discuss removal and remarking on your network.
